🙏 Please keep this project in your prayers—for both the construction process and funding. While a loan has been secured to cover the remaining portion of the $2.15 million total cost, we’re praying boldly that the Lord will provide in such a way that those borrowed funds won’t be needed. He owns the cattle on a thousand hills, and we trust Him to provide beyond what we could ask or imagine.
Funds Raised as of 10/15/2025 = $1,296,549.30 (NEED $853,450.70 MORE TO FULLY FUND)
construction log:
NEW CHAPEL GROUNDBREAKING SERVICE - SEPTEMBER 14, 2025
August 25 - Contractors meet adjacent to the future chapel site.

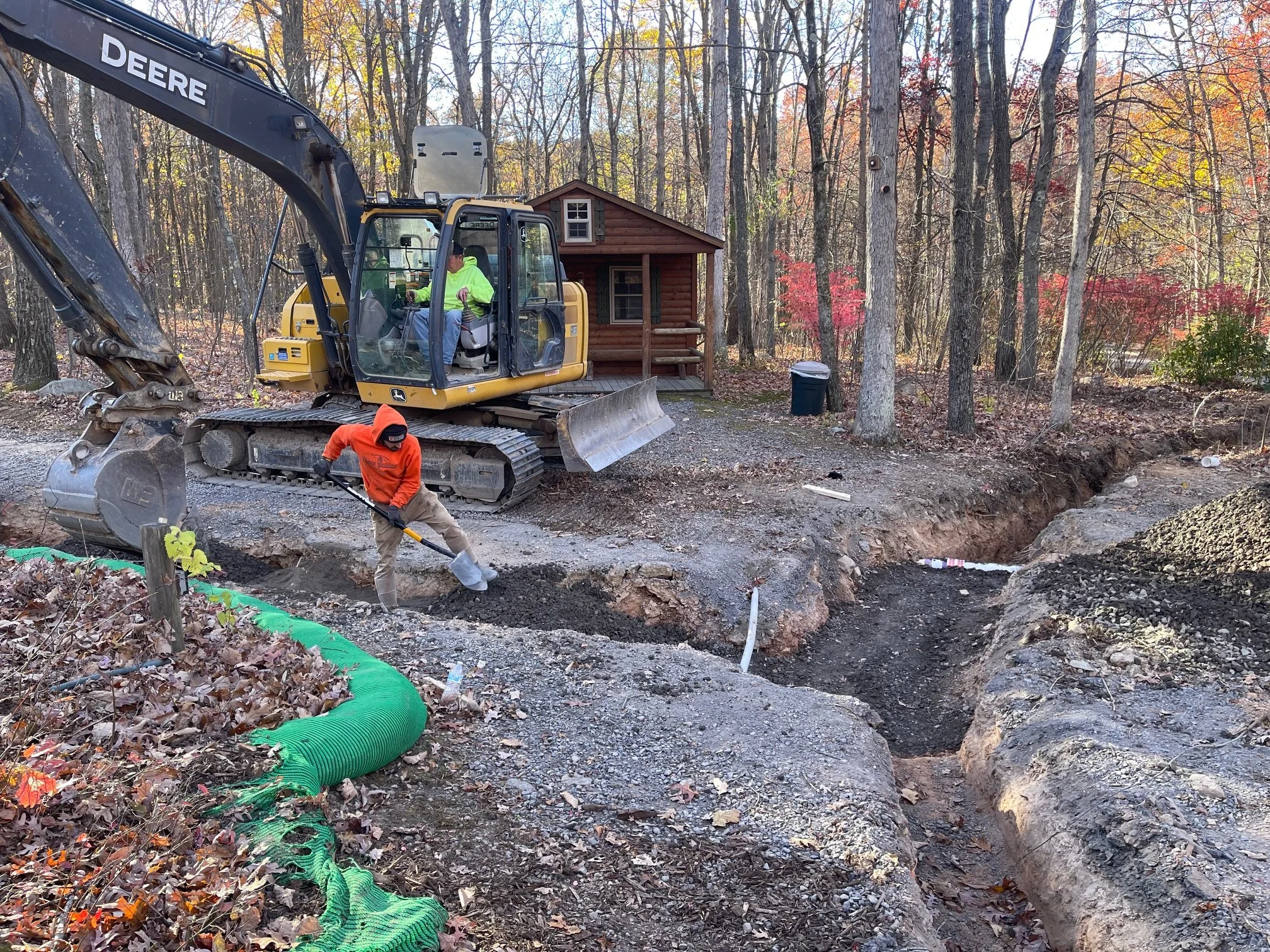

September 2 – Construction began with preparations below the ballfield to receive ground fill from the chapel construction site.

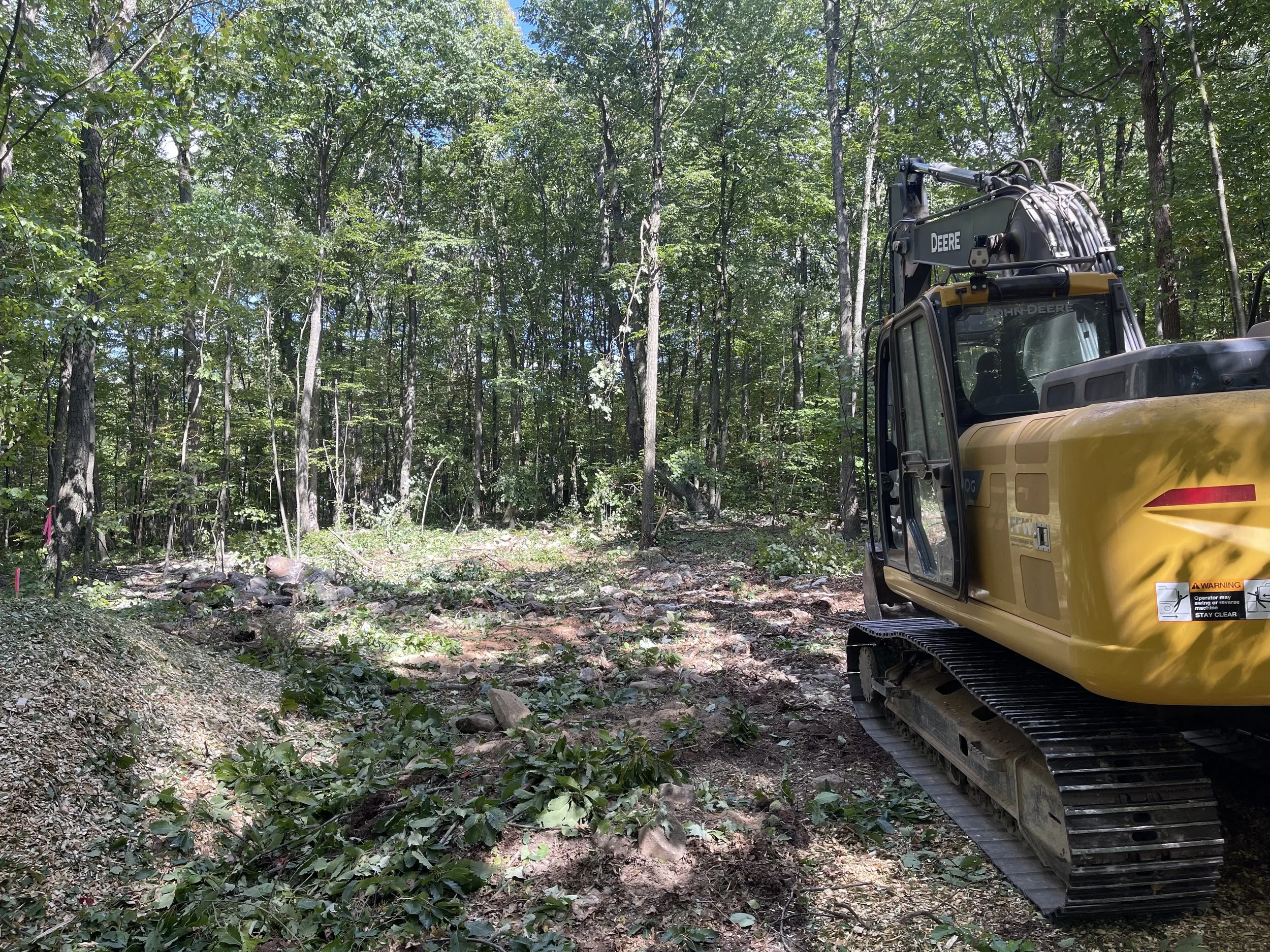

September 3 – Tree removal and ground preparation work started at the construction site.
September 4-5, 8-9 - Continued tree removal and ground prep. Tree removal is nearly complete.

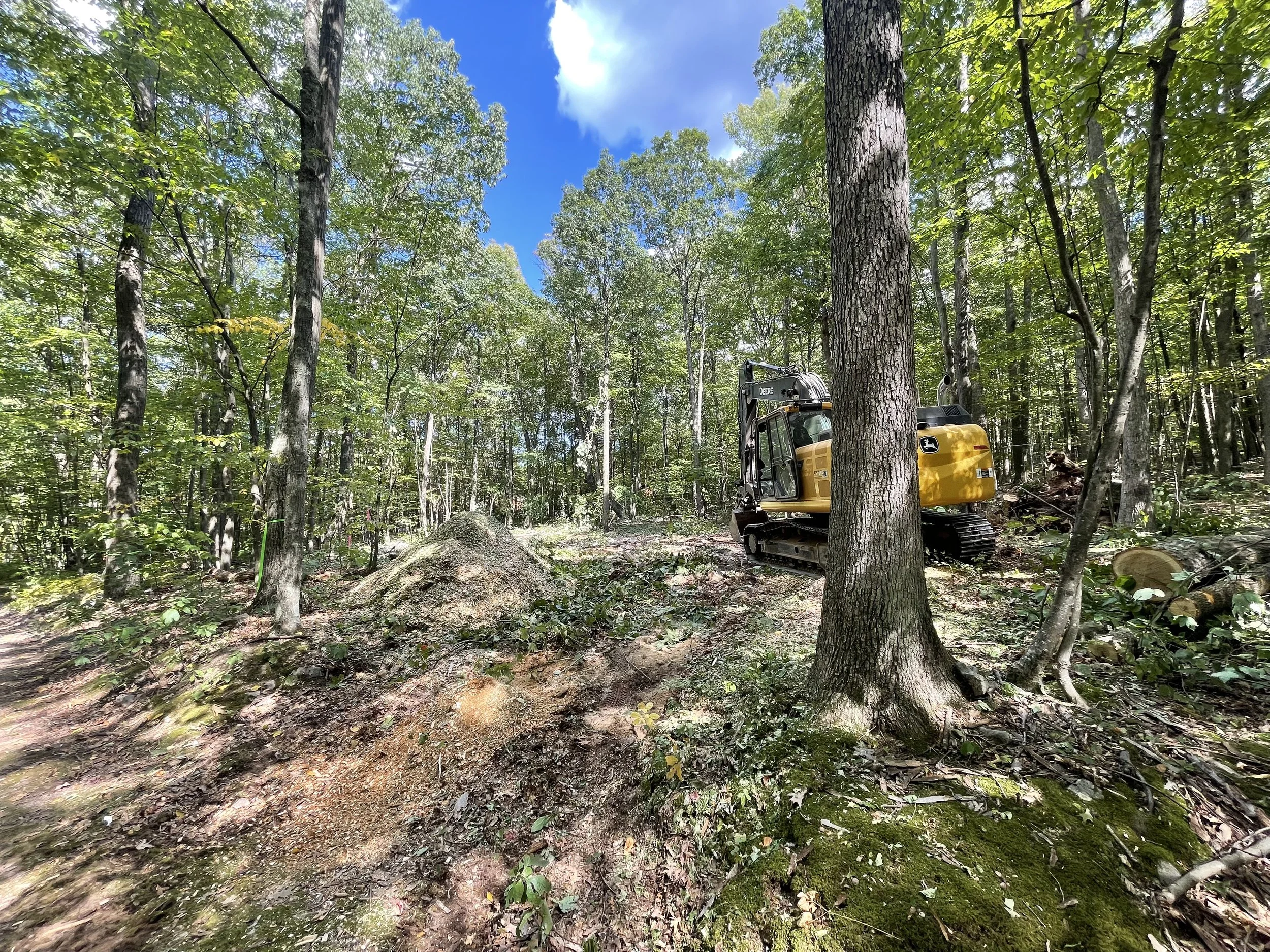

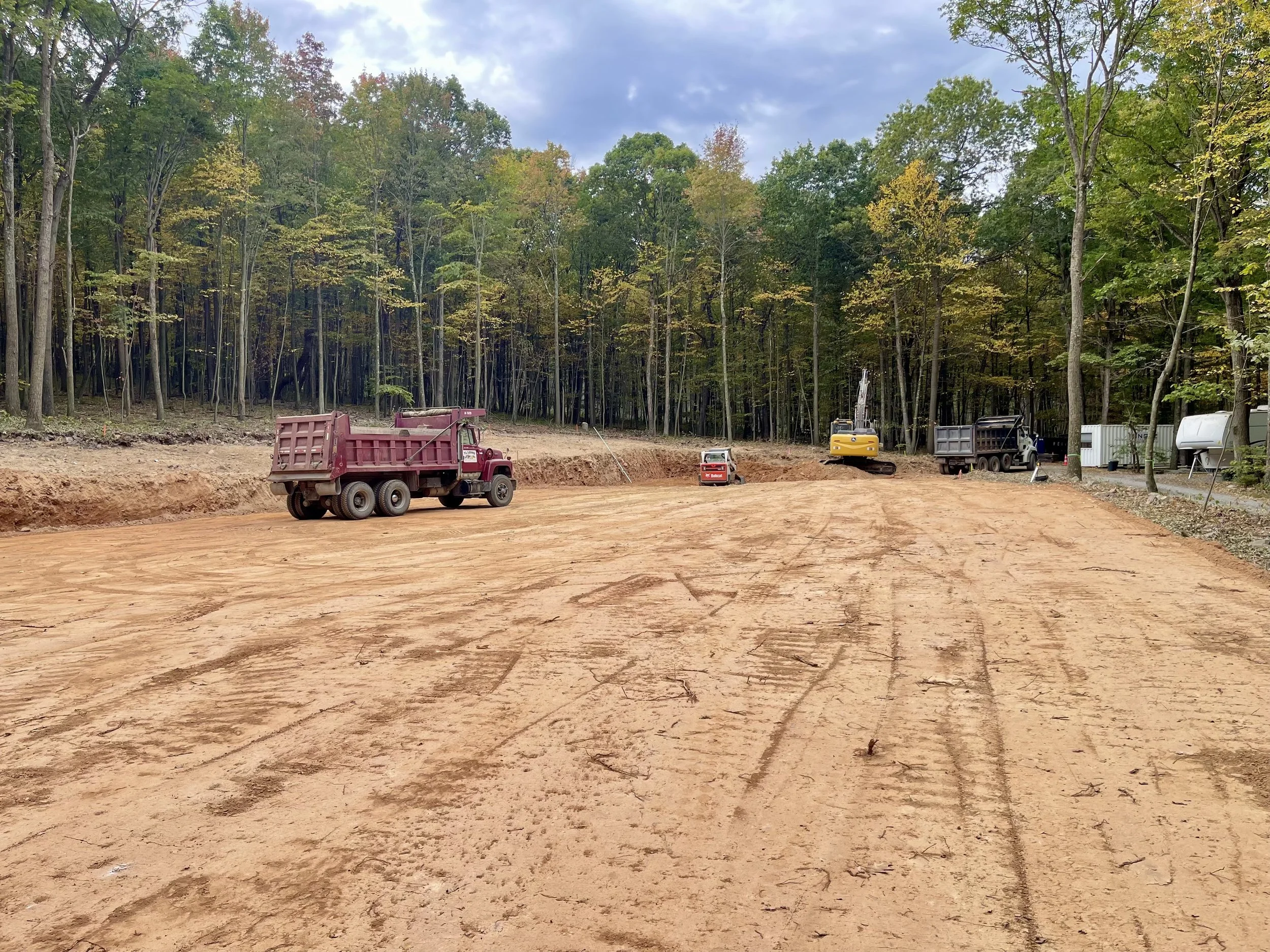

September 10 - Logs were trucked out and clearing finished. Dirt will be flying soon.
September 11 - Limit of disturbance marked by surveyors and site leveling begins.
September 14 - Groundbreaking service held on the site.
September 15-17 - Dirt is flying! Ground Prep continues…

October 31 - The big section of the roof is complete!
September 19 - Ready to dig footers on Monday!
September 22 - Footers were dug.
September 23 - Rebar placed for footers. First wet day of construction.
September 24 - Footers poured. Just a light rain.

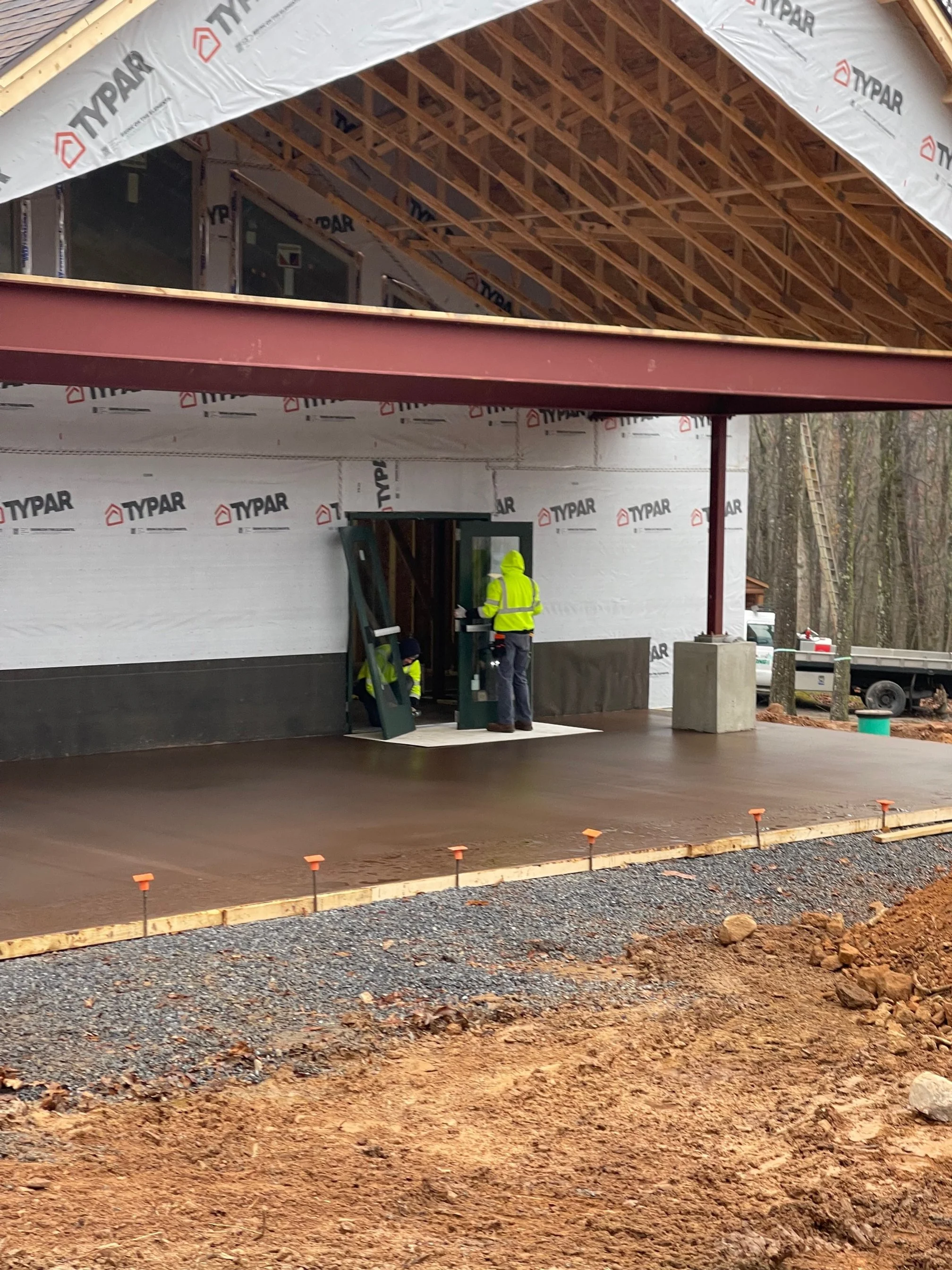

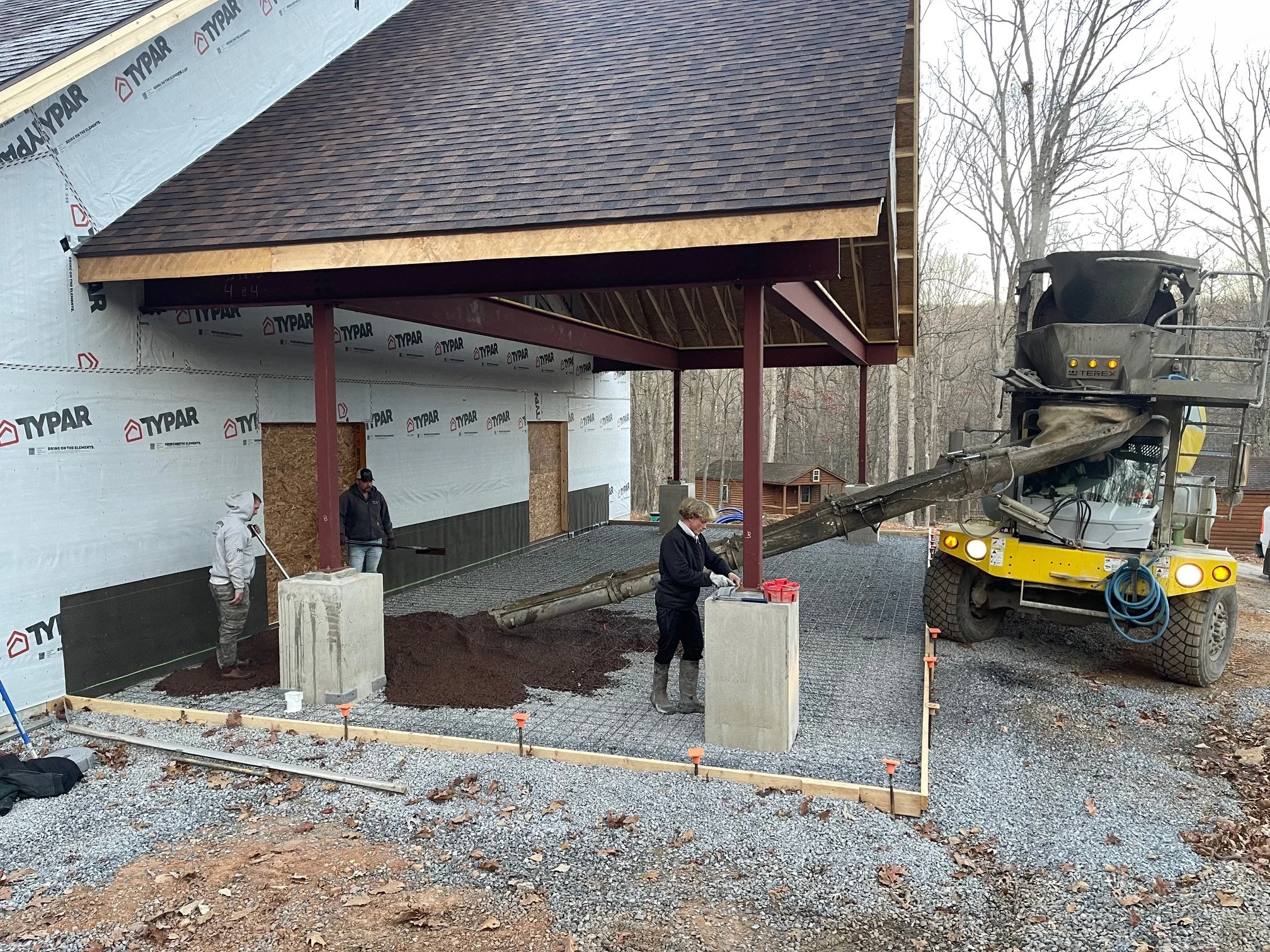

September 29 - Forms placed and foundation walls and piers poured.
September 30 - Steel arrives and insulation installed on foundation wall.

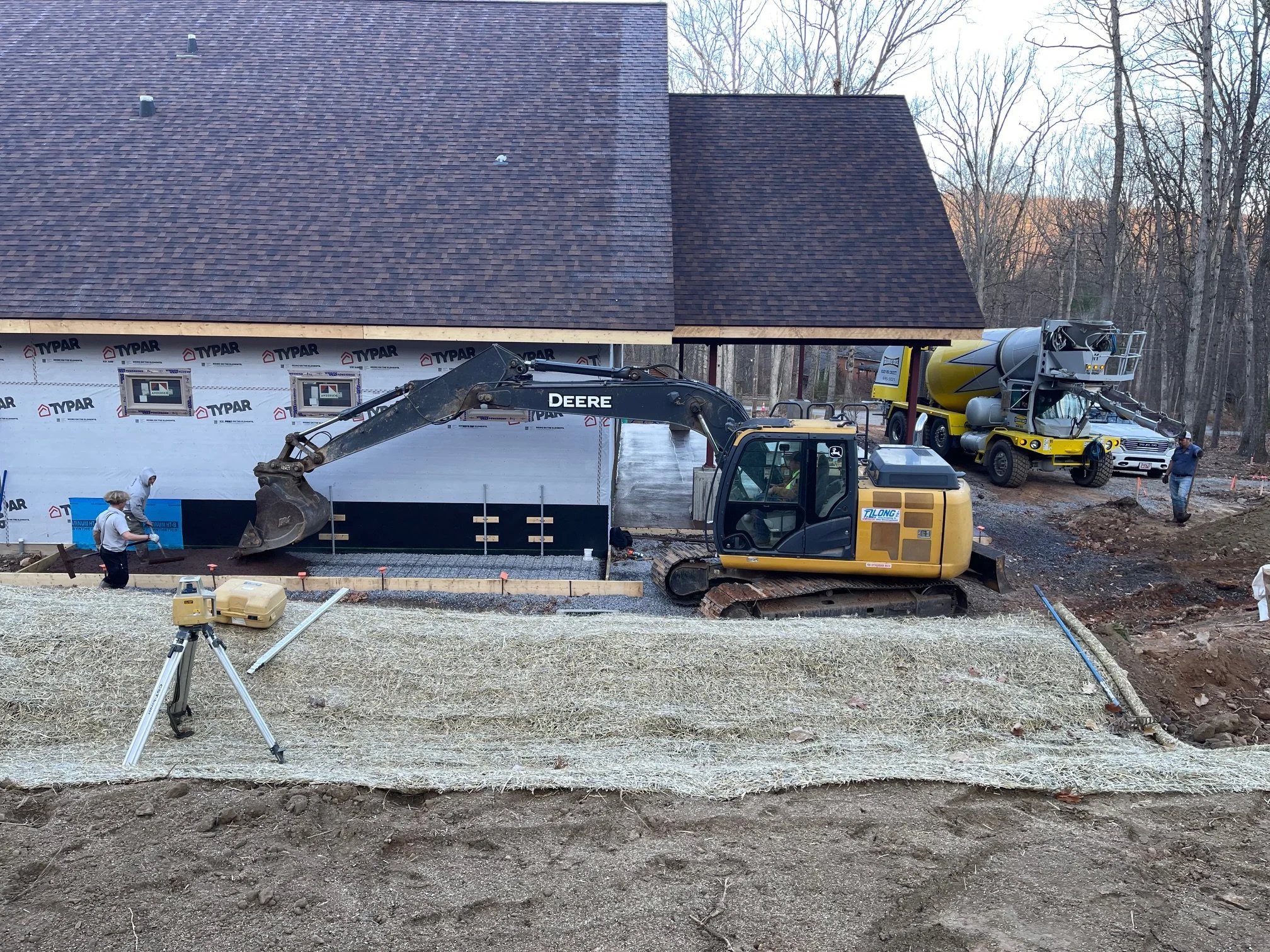

October 1 - 2 - Steel posts installed, some conduits placed, and wall backfilled.

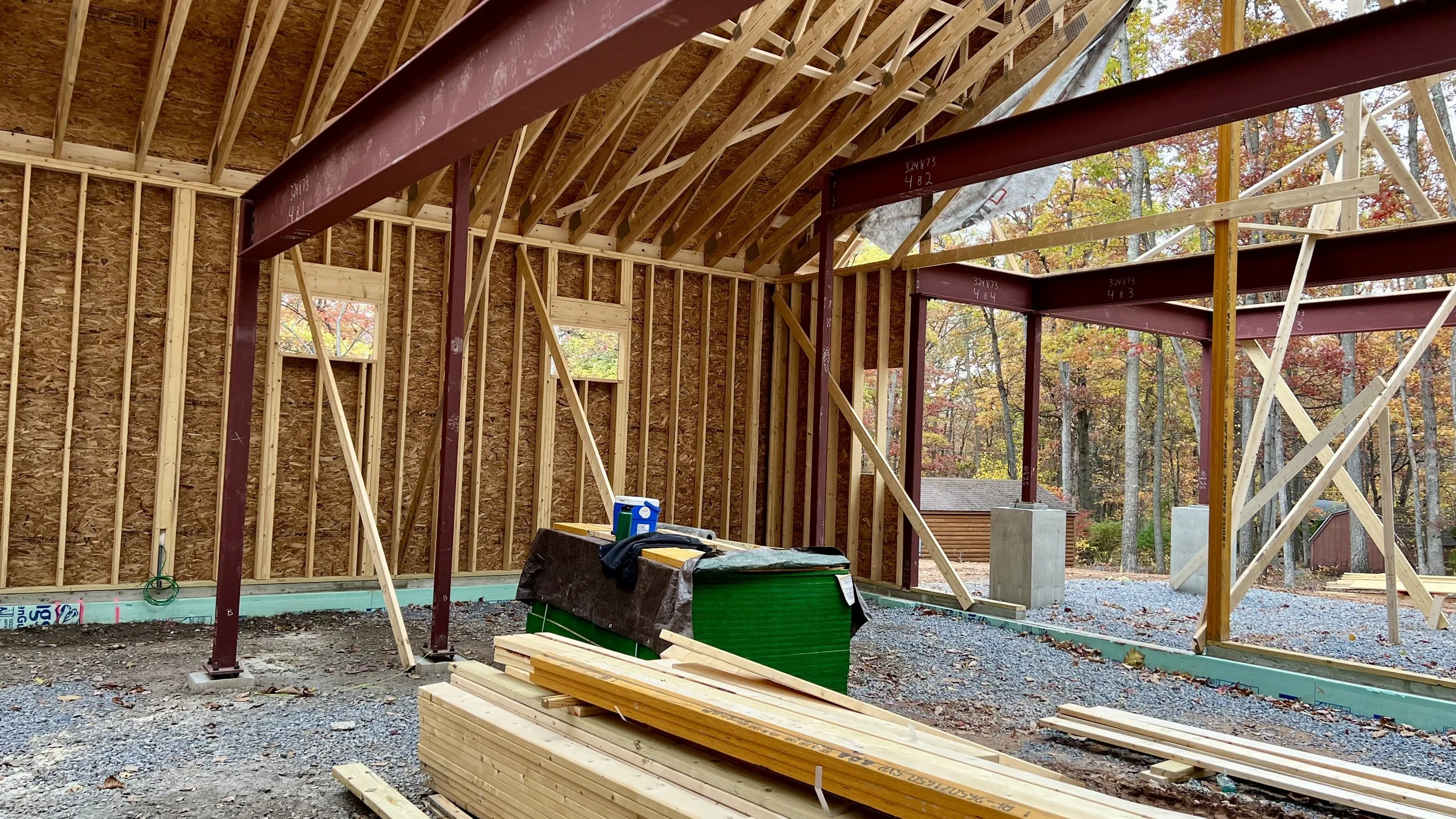

October 3 - Steel Framework Installed.
October 6-10 - Wood framiing begins
October 13-16 - work has paused somewhat as we wait for trusses on Friday.

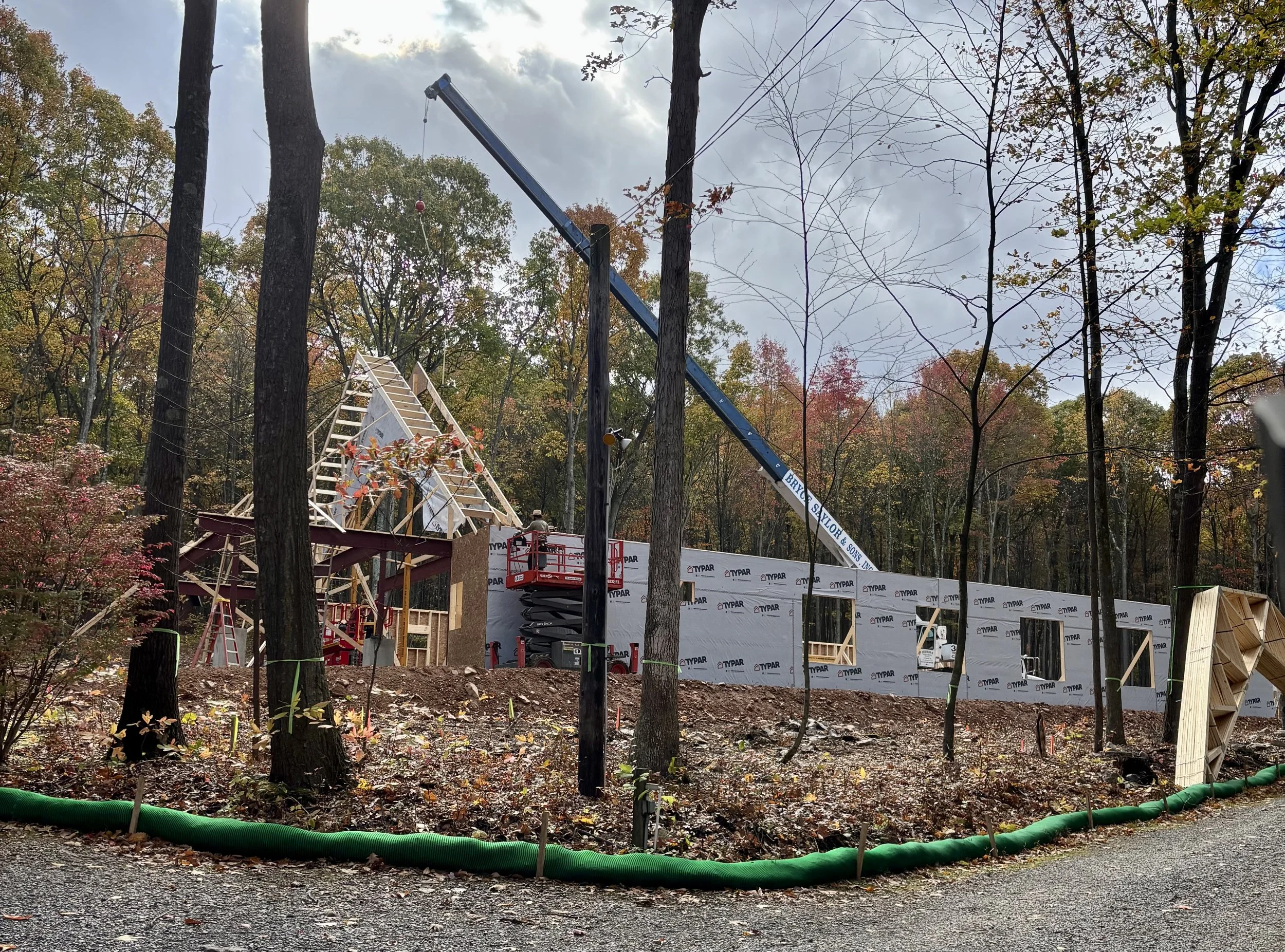

October 17 - Trusses arrive on two trucks and will be lifted into place early next week.

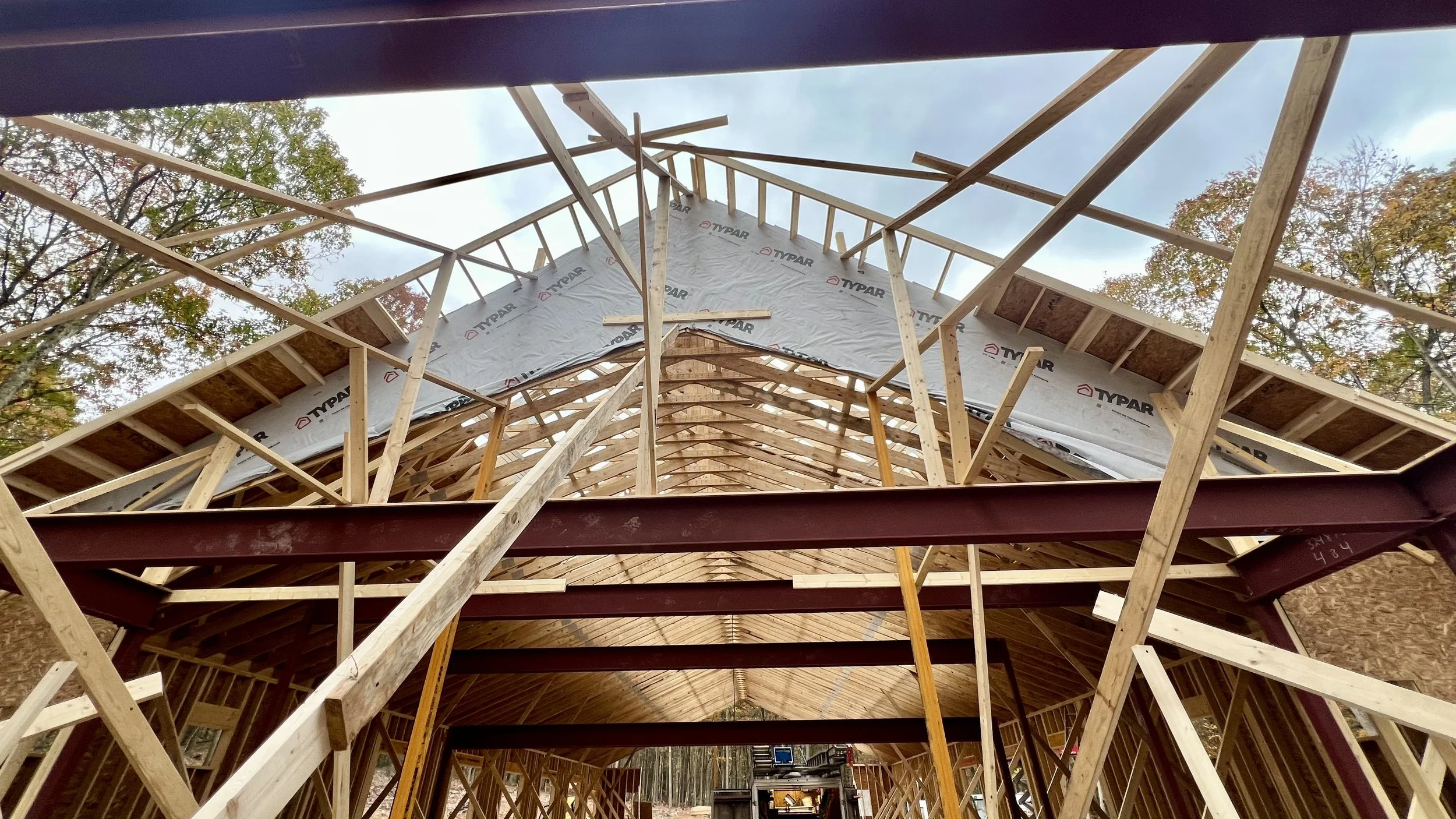

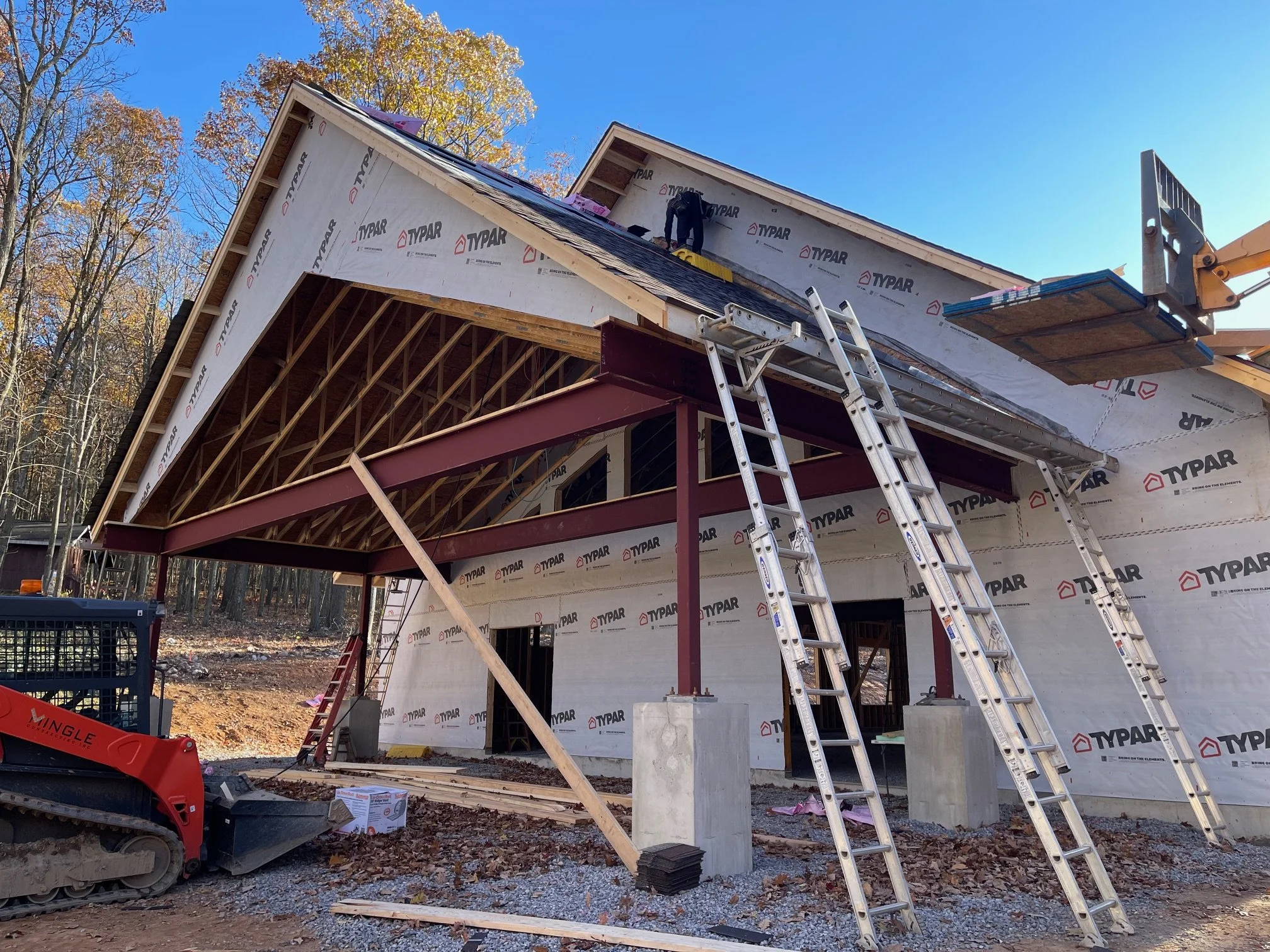

OCTOBER 20-22 - TRUSSES INSTALLED
October 22-24 - Roof Sheeting/Shingling
October 27-31 - Shingling, electrical conduits, rough plumbing, stormwater drains, collar ties, end wall framing.
View fullsize
Aug 25-Contractors meet adjacent to the site.
View fullsize

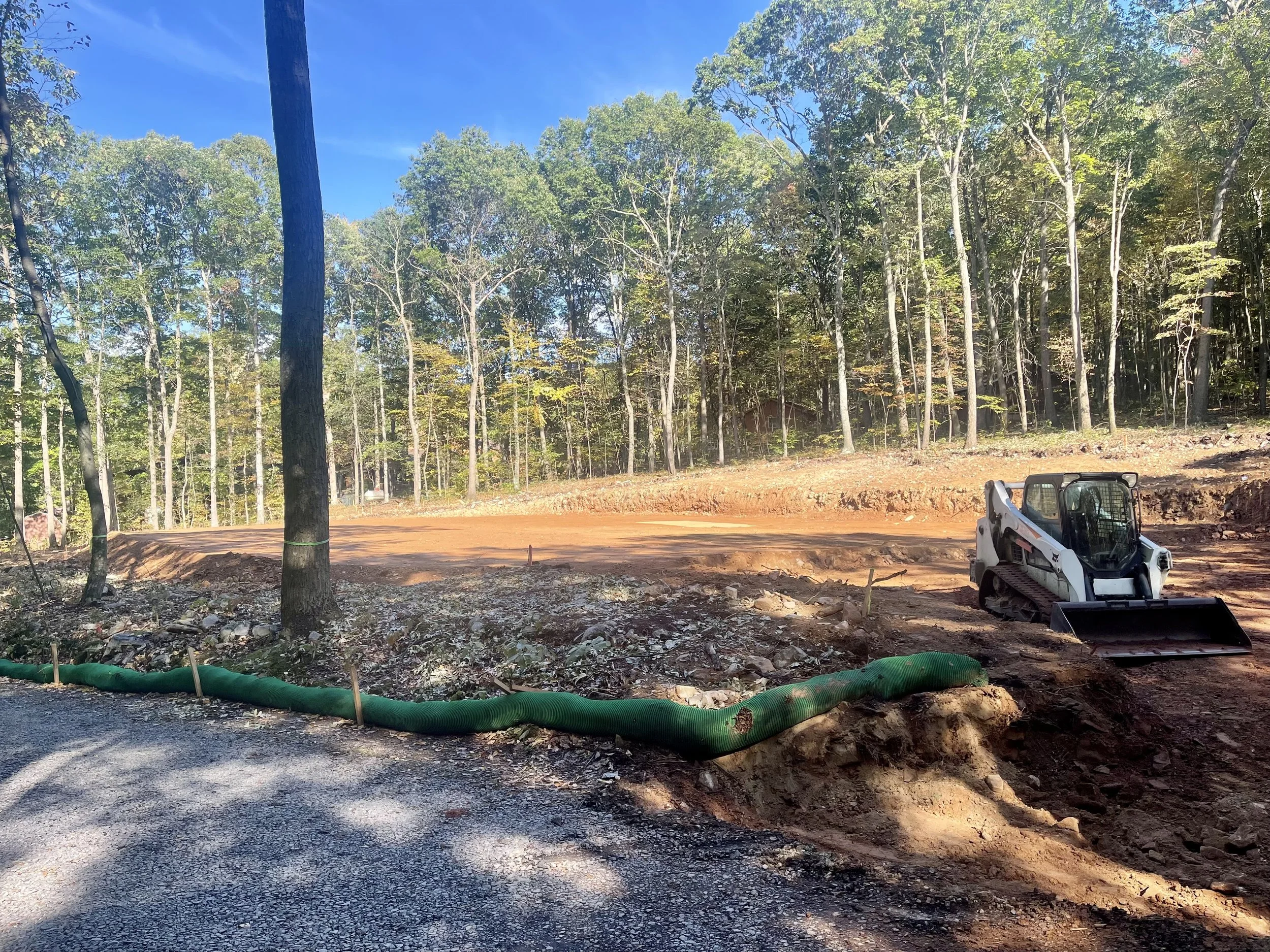

Sept 3-Tree removal/site preps
View fullsize
Sept 10-The first truckload of logs being loaded up.
View fullsize
Sept. 12 - The site being leveled.
View fullsize
Sept 14 - Groundbreaking Service!
View fullsize
Sept 15 - Dirt is flying!
View fullsize
Sept 17 - Ground prep continues
View fullsize
Sept 19 - Ready to dig footers
View fullsize
Sept. 22 - Footers being dug
View fullsize
Sept. 23 - Rebar placed in footers
View fullsize
Sept. 24 - Footers being poured.
View fullsize
Sept. 29 - Forming and pouring foundation wall
View fullsize
September 29 - Forms placed and foundation walls and piers poured.
View fullsize
Sept. 30 - Steel arrives
View fullsize

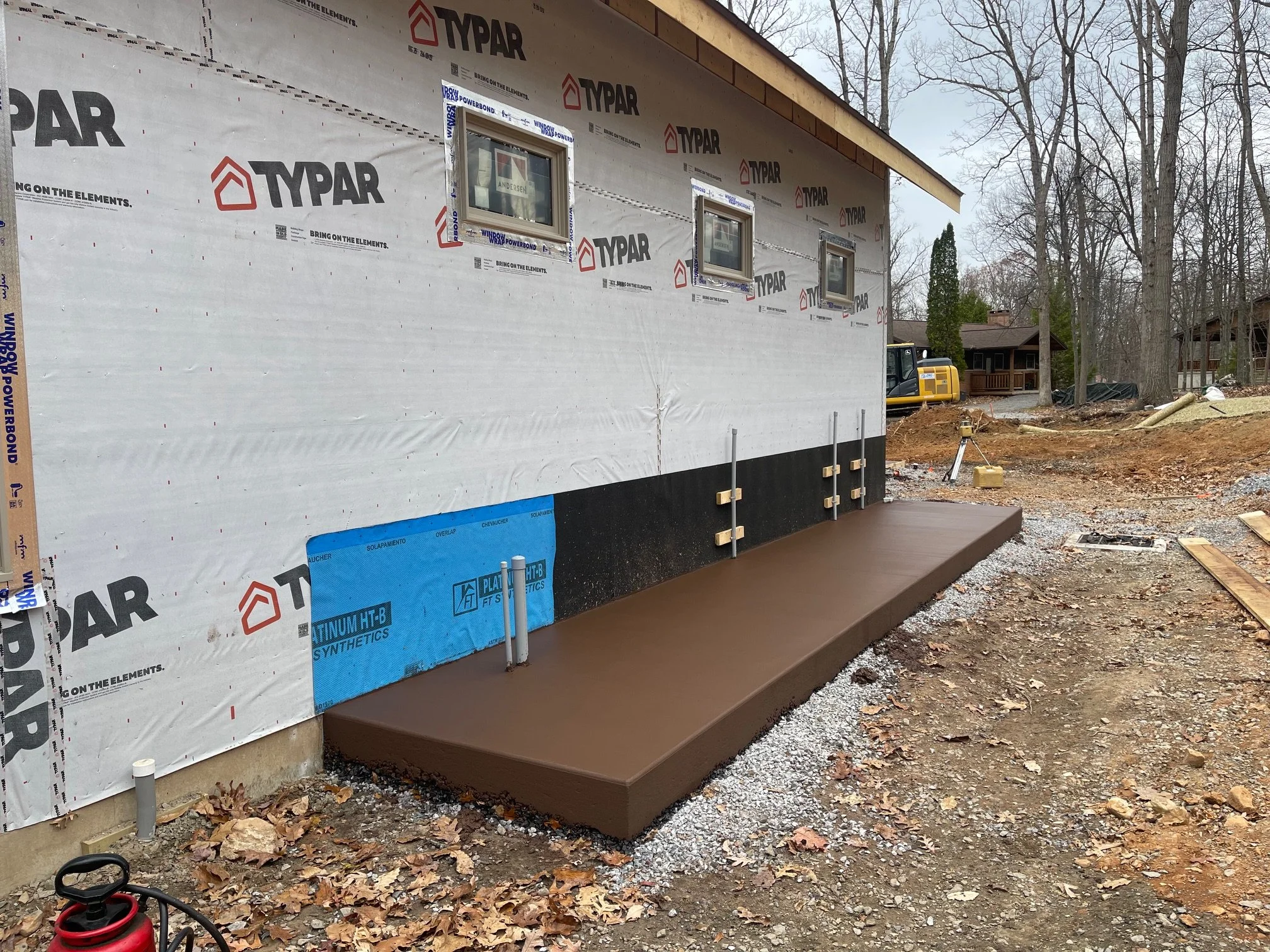

Sept 30 - Foam installed
View fullsize
Oct. 1 - Some posts installed
View fullsize
Oct. 2 - Conduit and backfilled
View fullsize

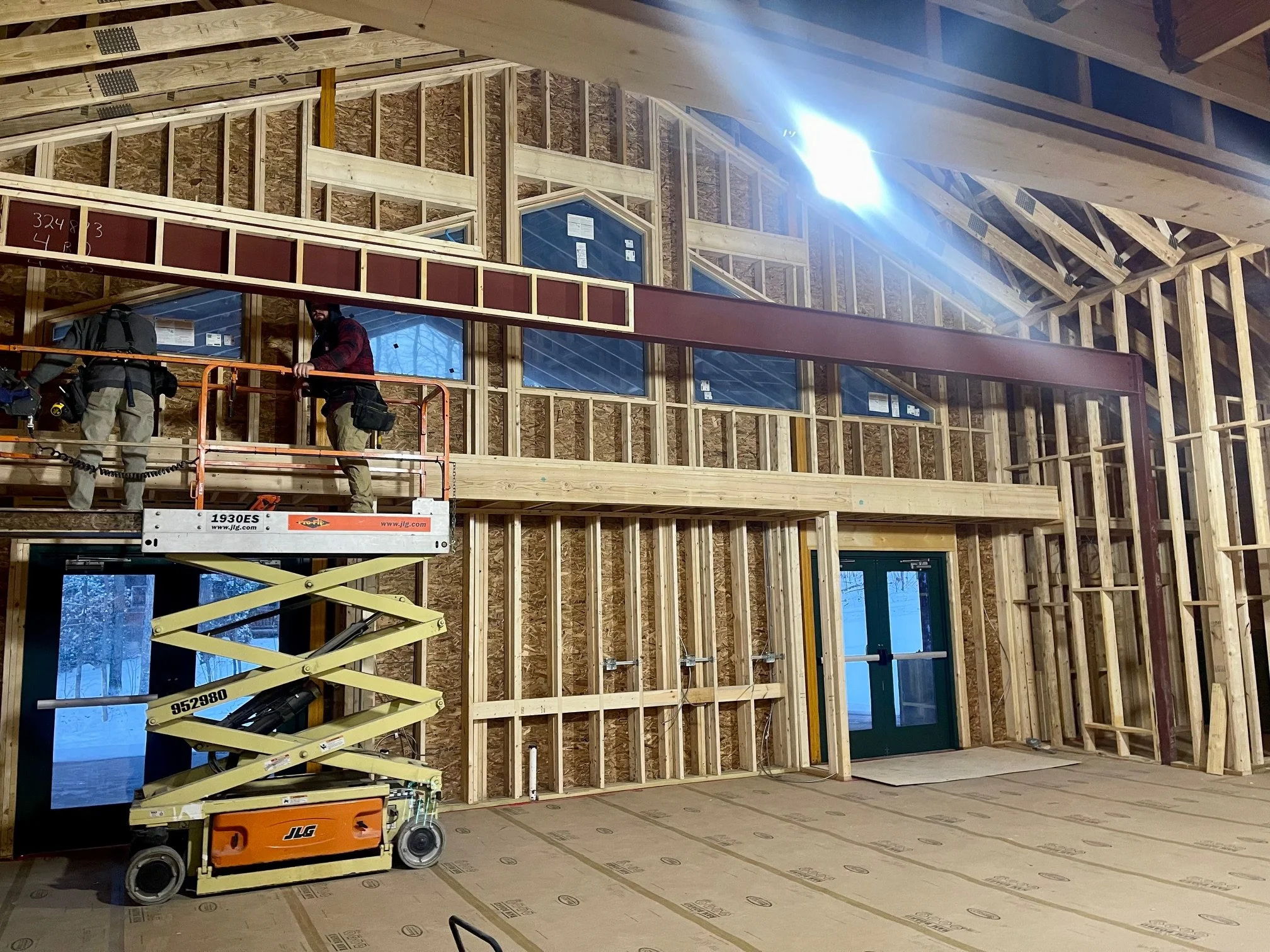

Oct. 3 - Steel framework installed.
View fullsize

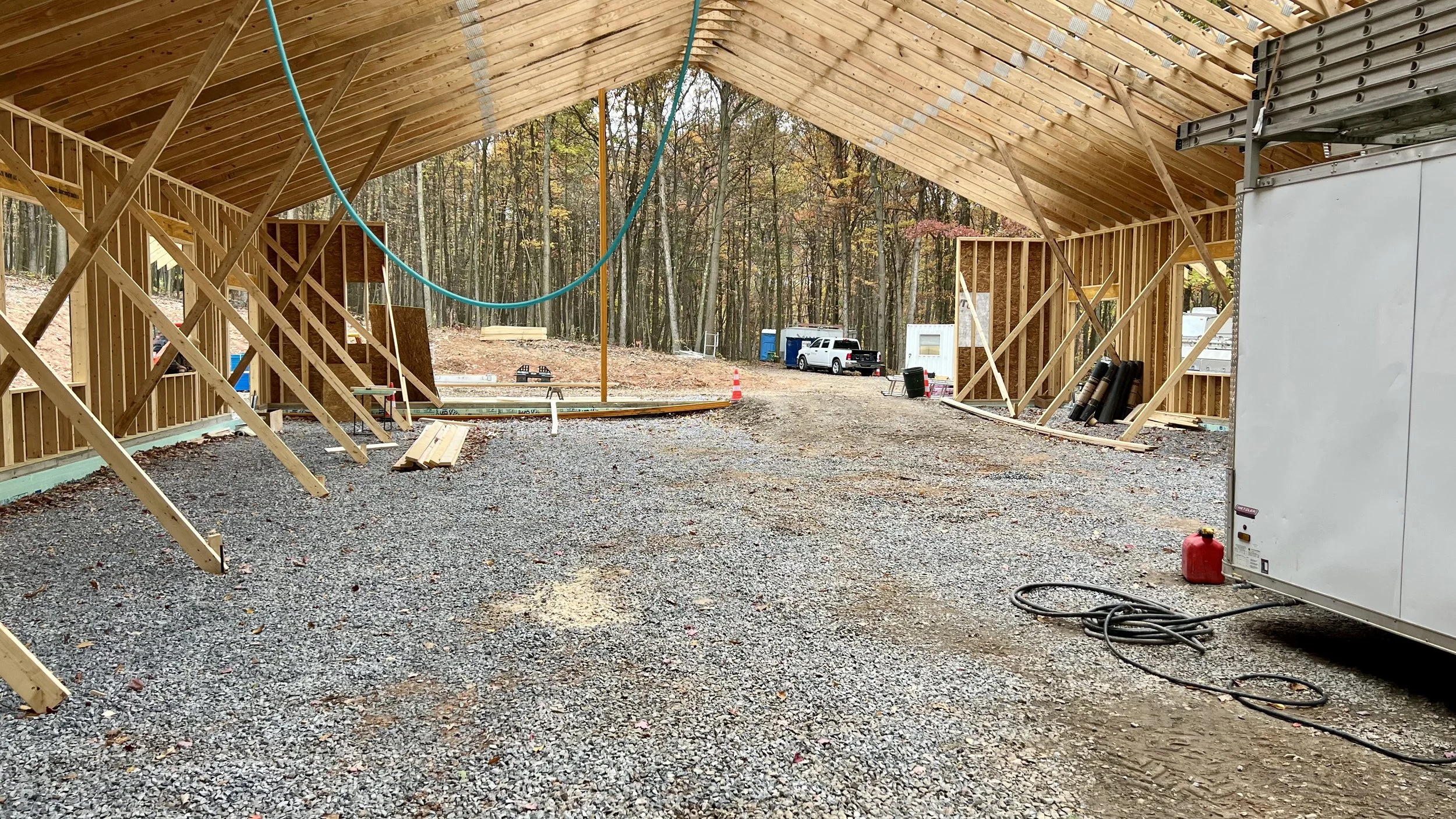

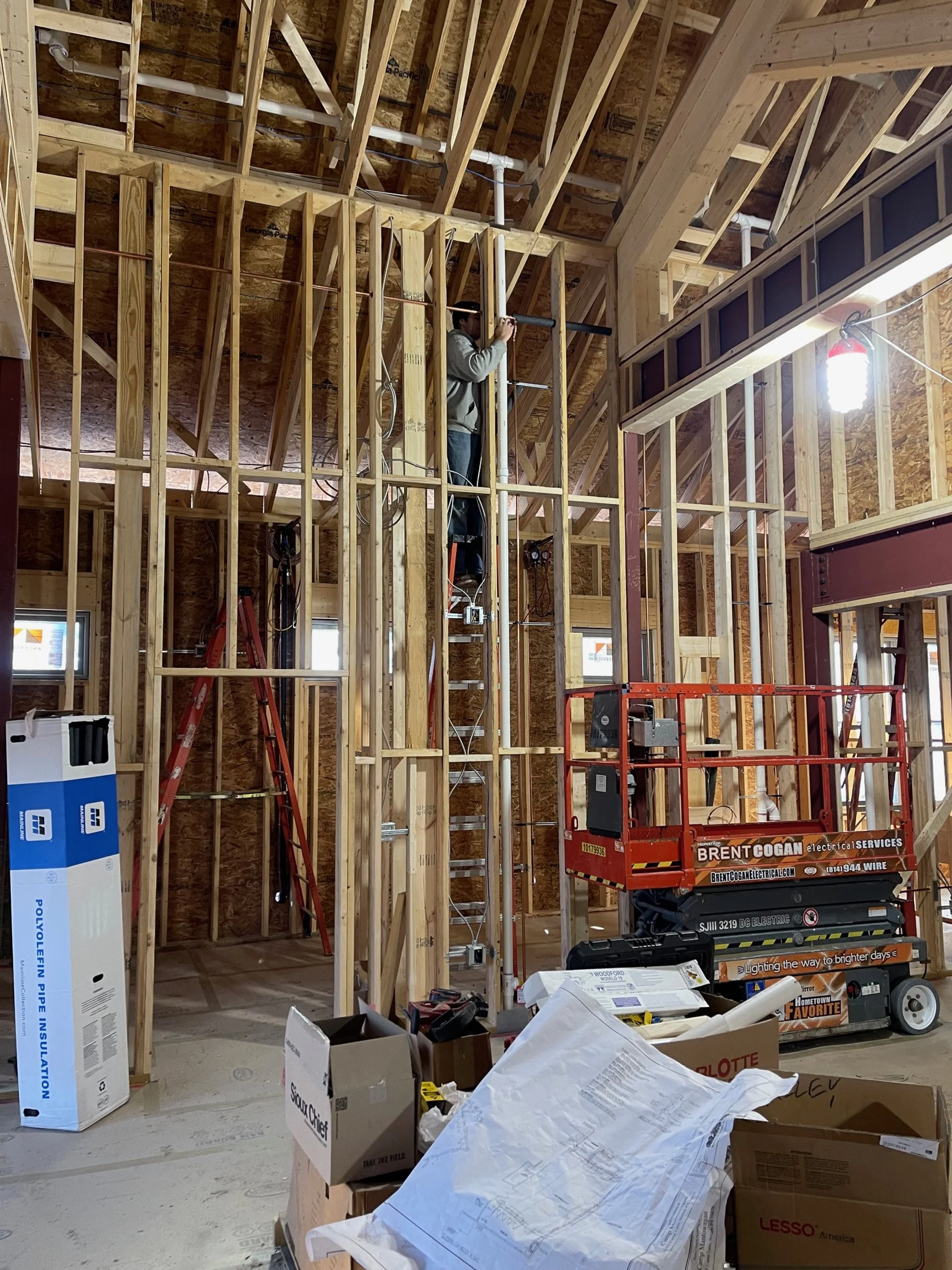

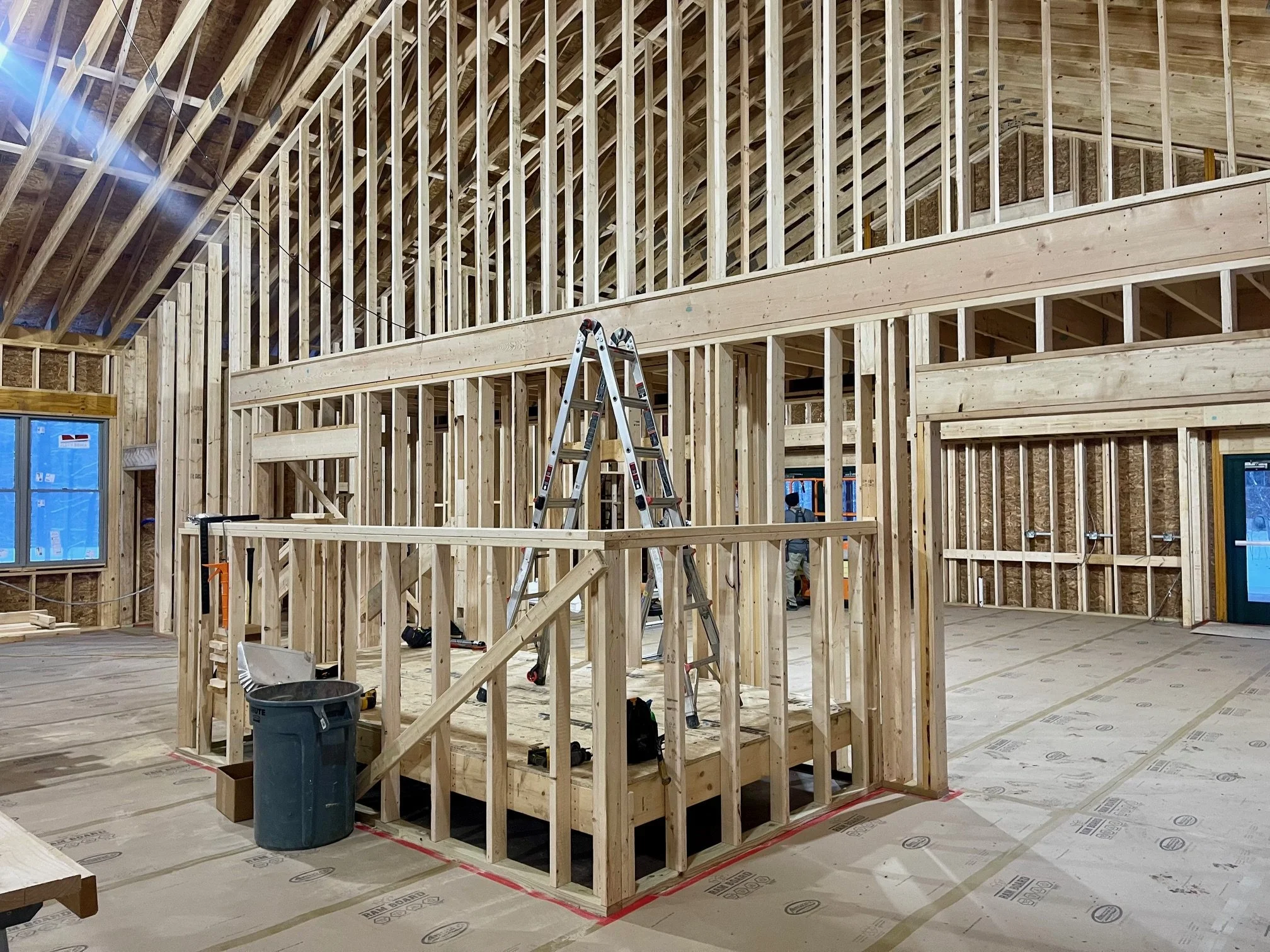

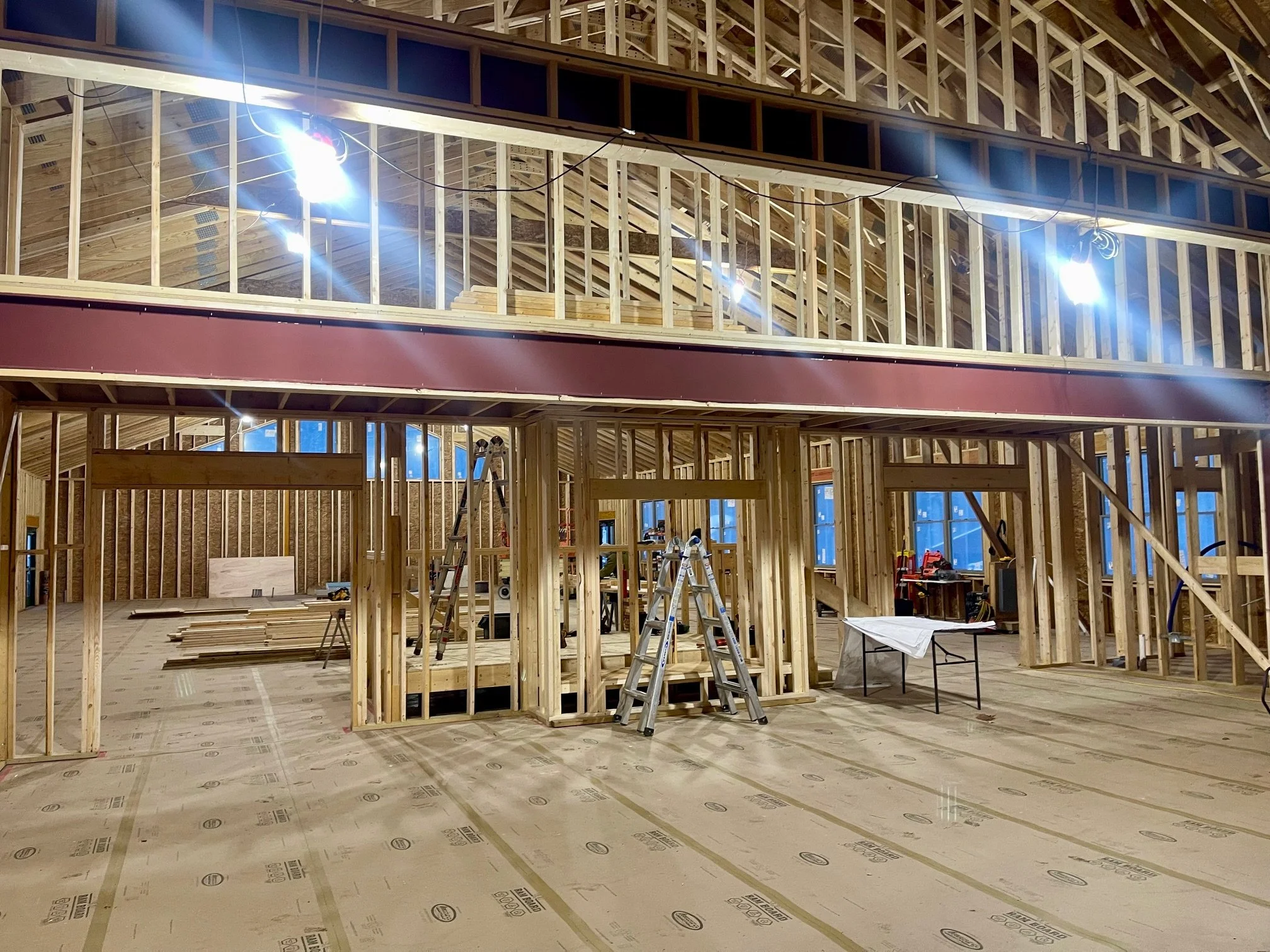

Oct. 6 - Framing begins!
View fullsize
Oct. 8 - Framing is progressing!
View fullsize

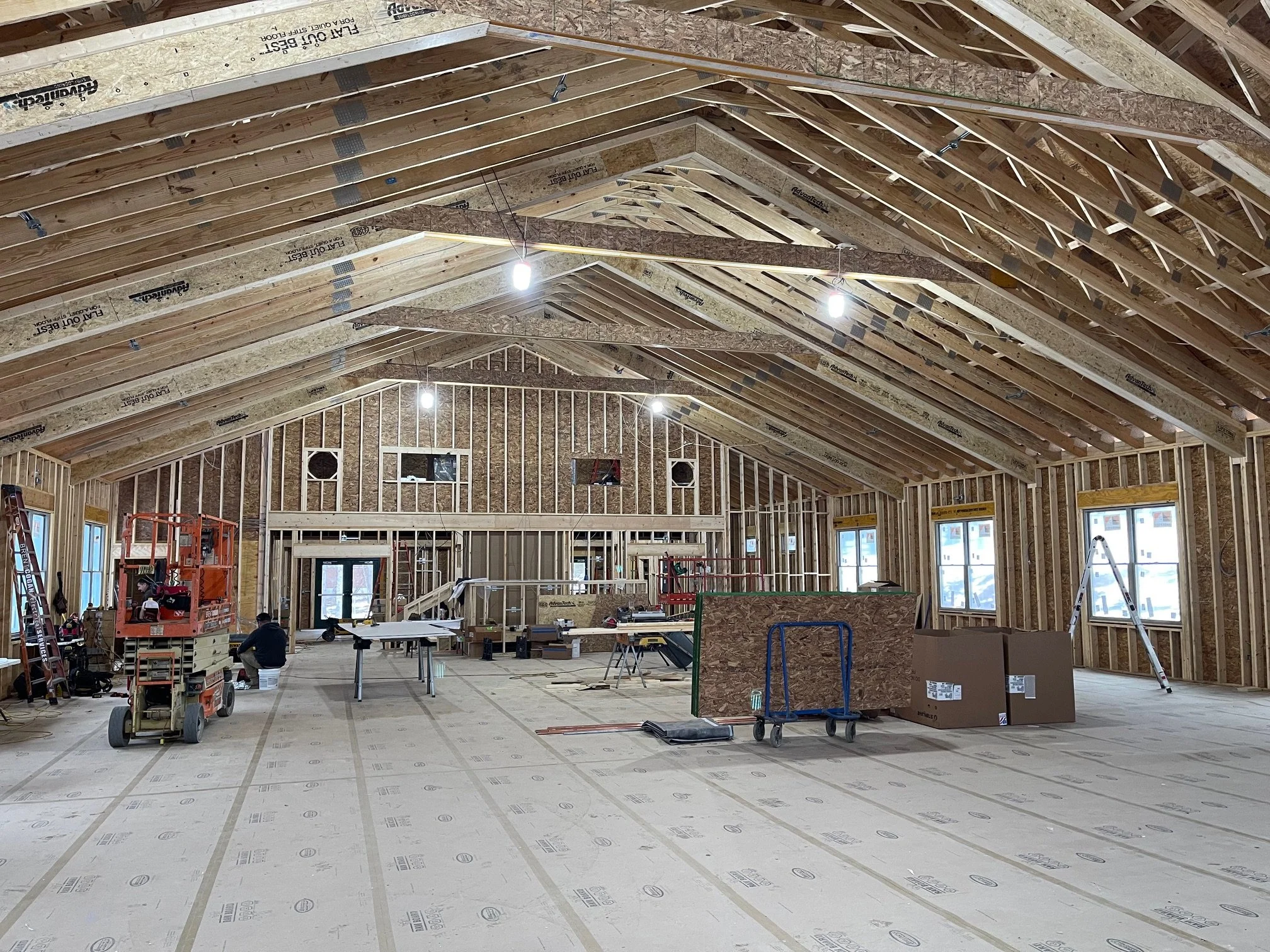

Oct. 17 - Trusses arrive!
View fullsize
Shipped in two pieces and assembled on site.
View fullsize

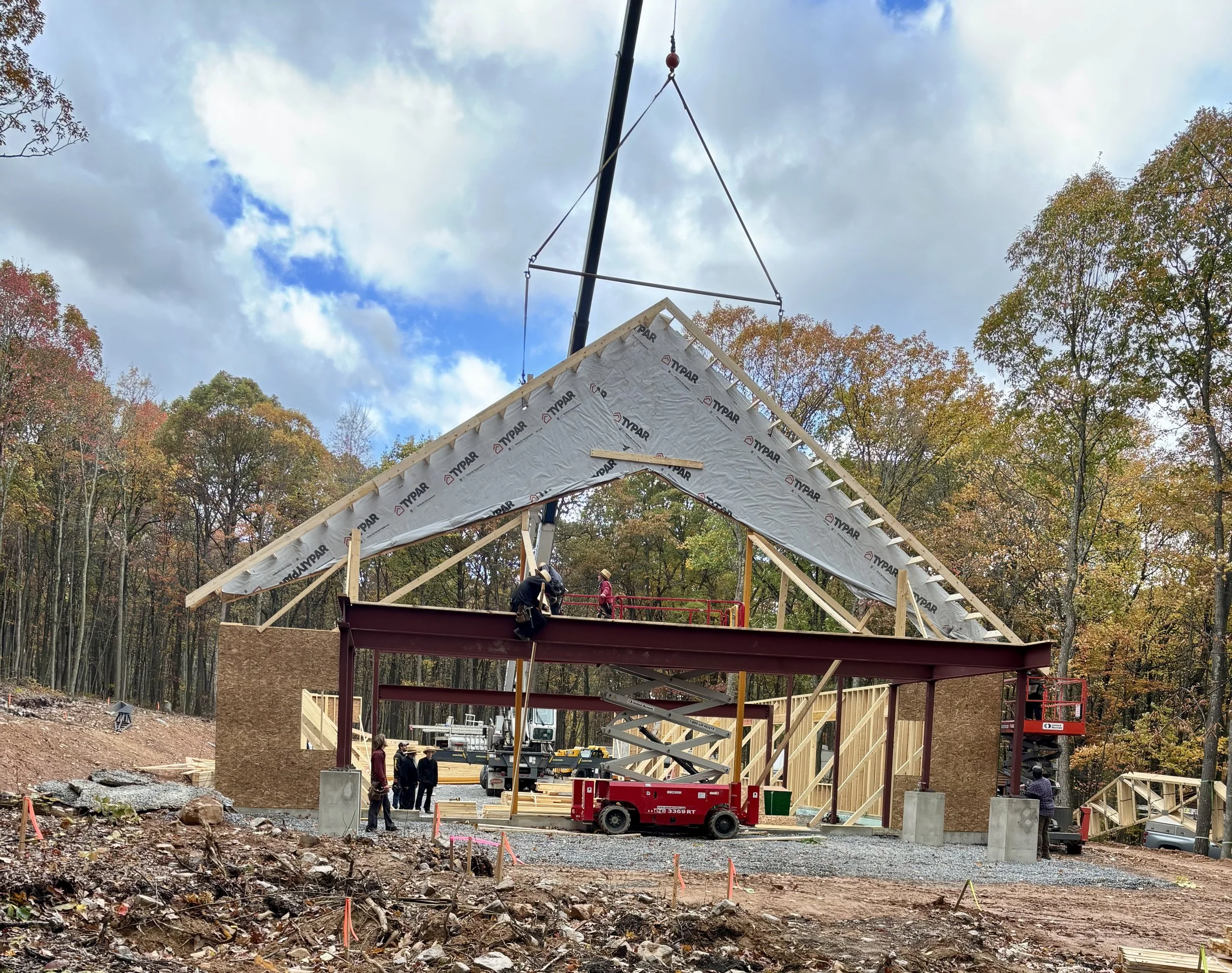

Oct. 20 - Trusses being installed
View fullsize
October 21
View fullsize
Oct. 22 - Last truss going up.
View fullsize
Oct. 22 - First row of sheeting.
View fullsize

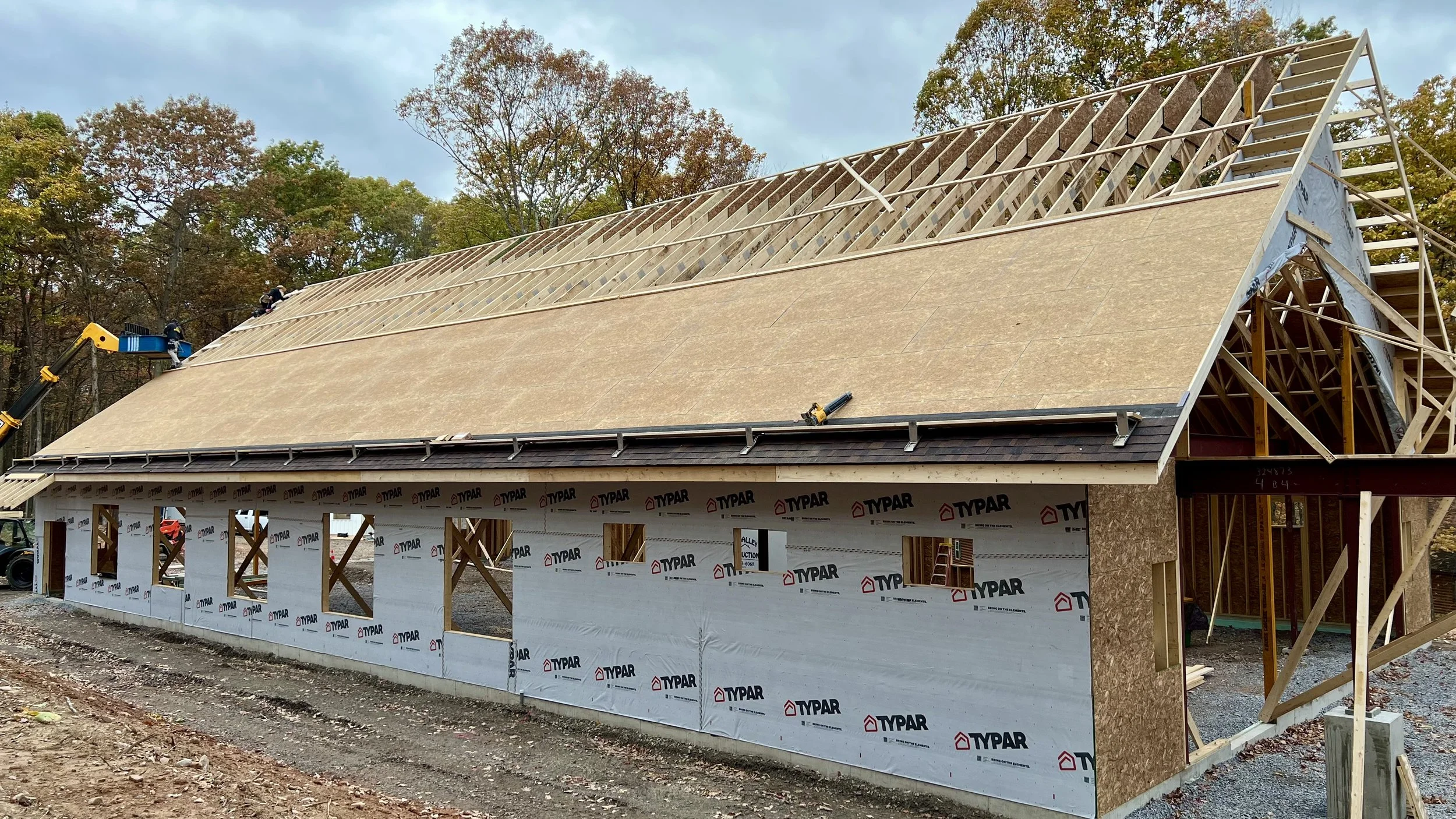

Oct. 23 - Roof sheeting continues.
View fullsize

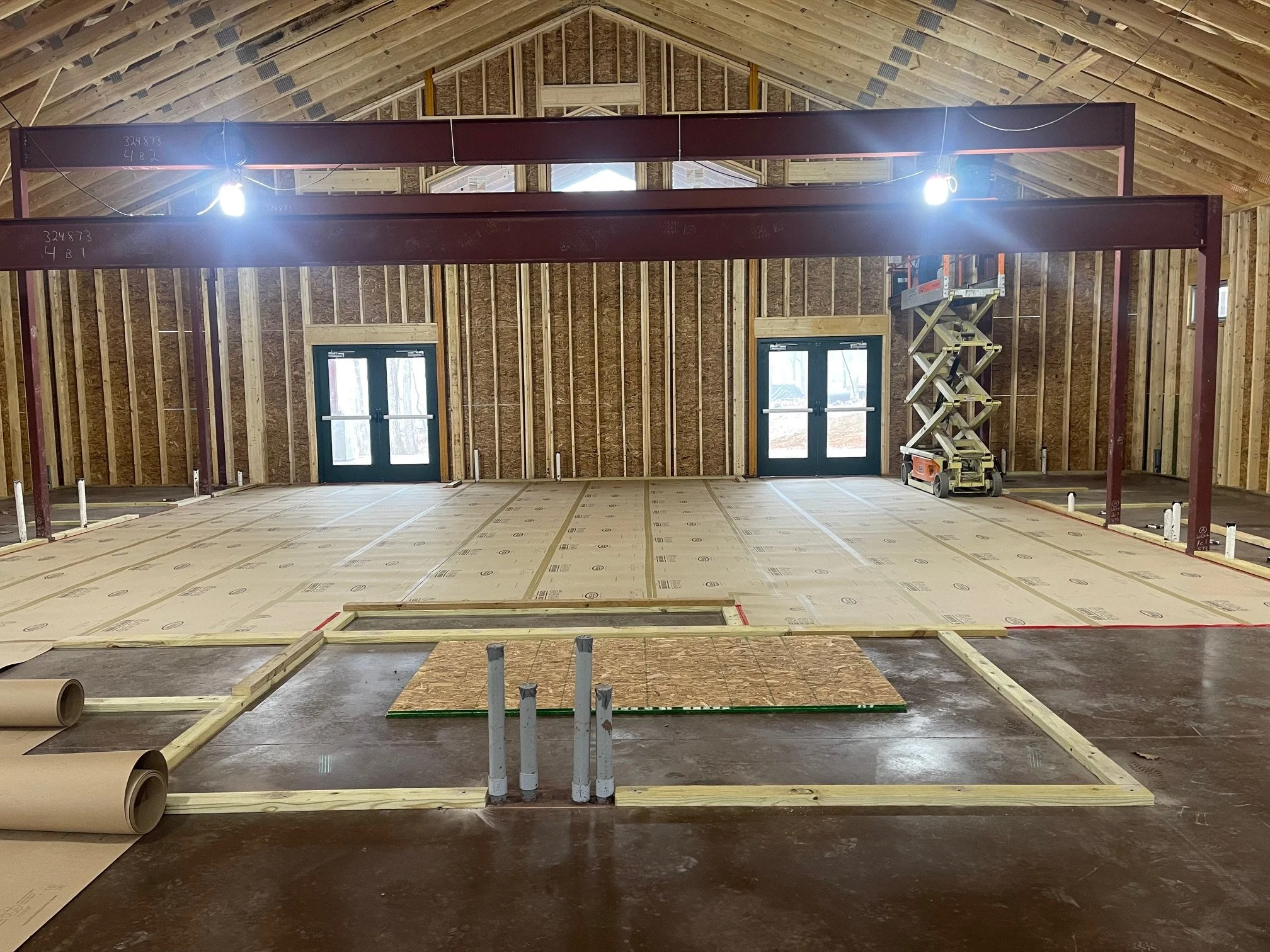

View from Dining Hall
View fullsize

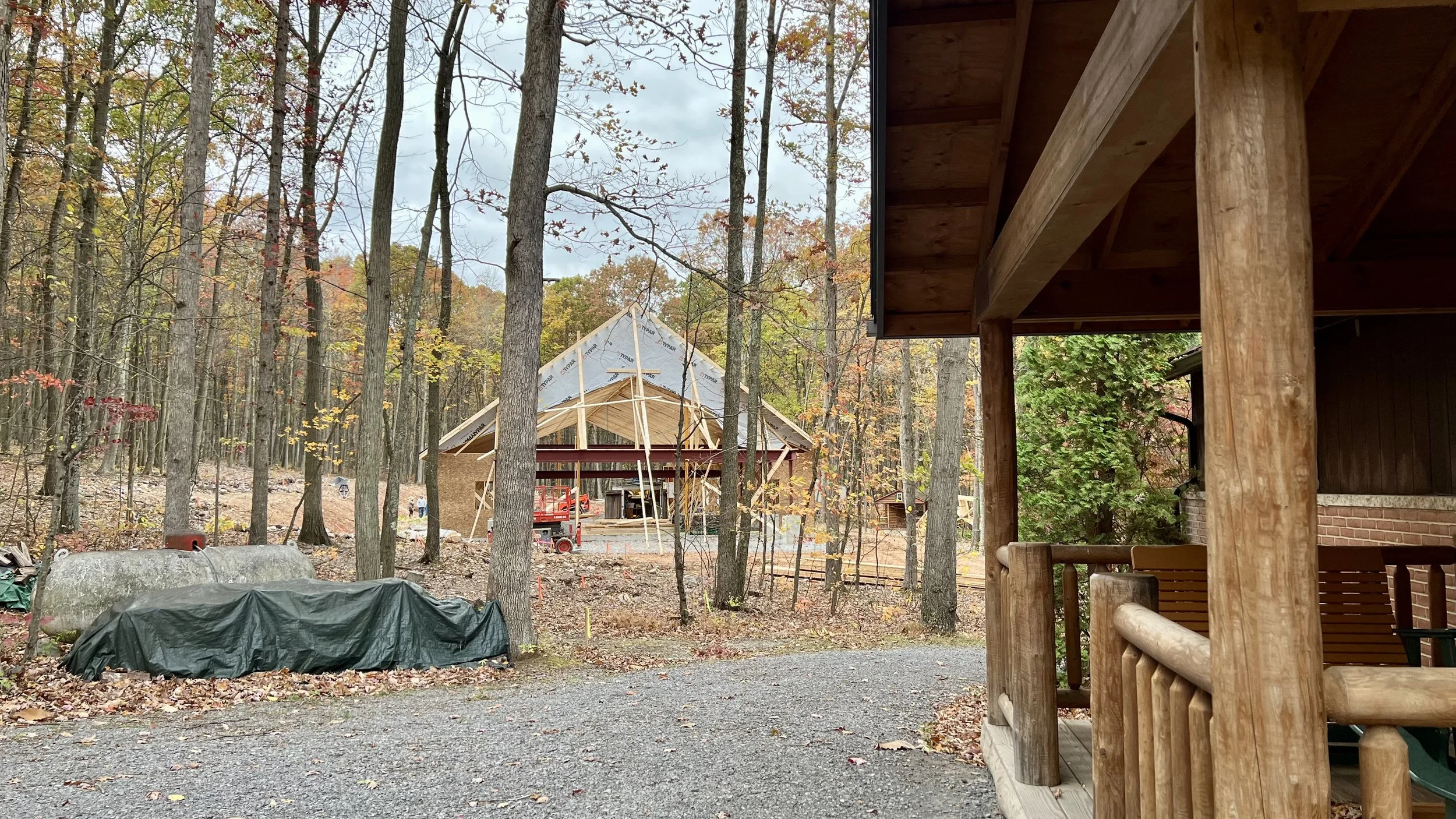

View from back of Lodge
View fullsize
Front of chapel (lobby area)
View fullsize

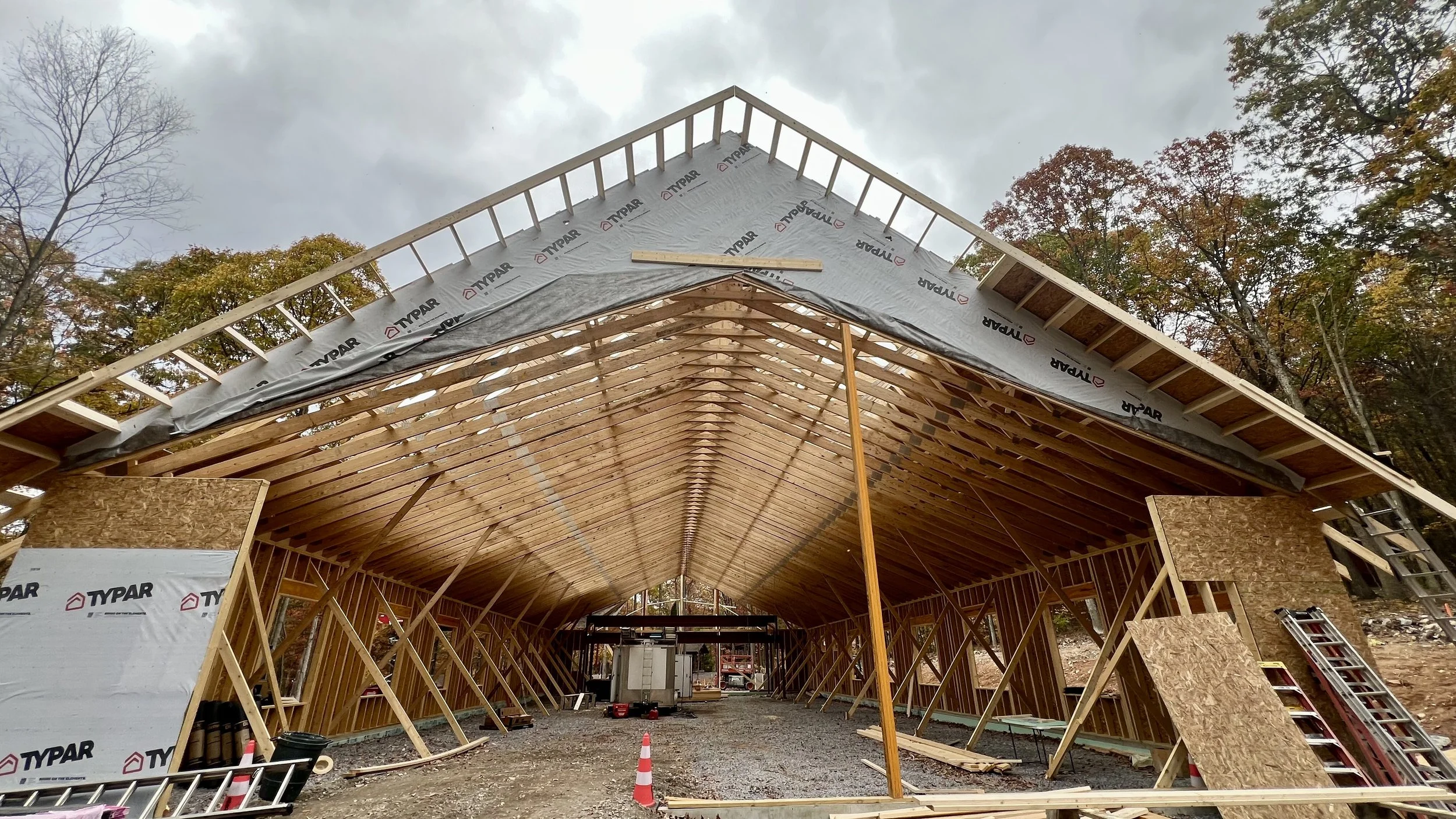

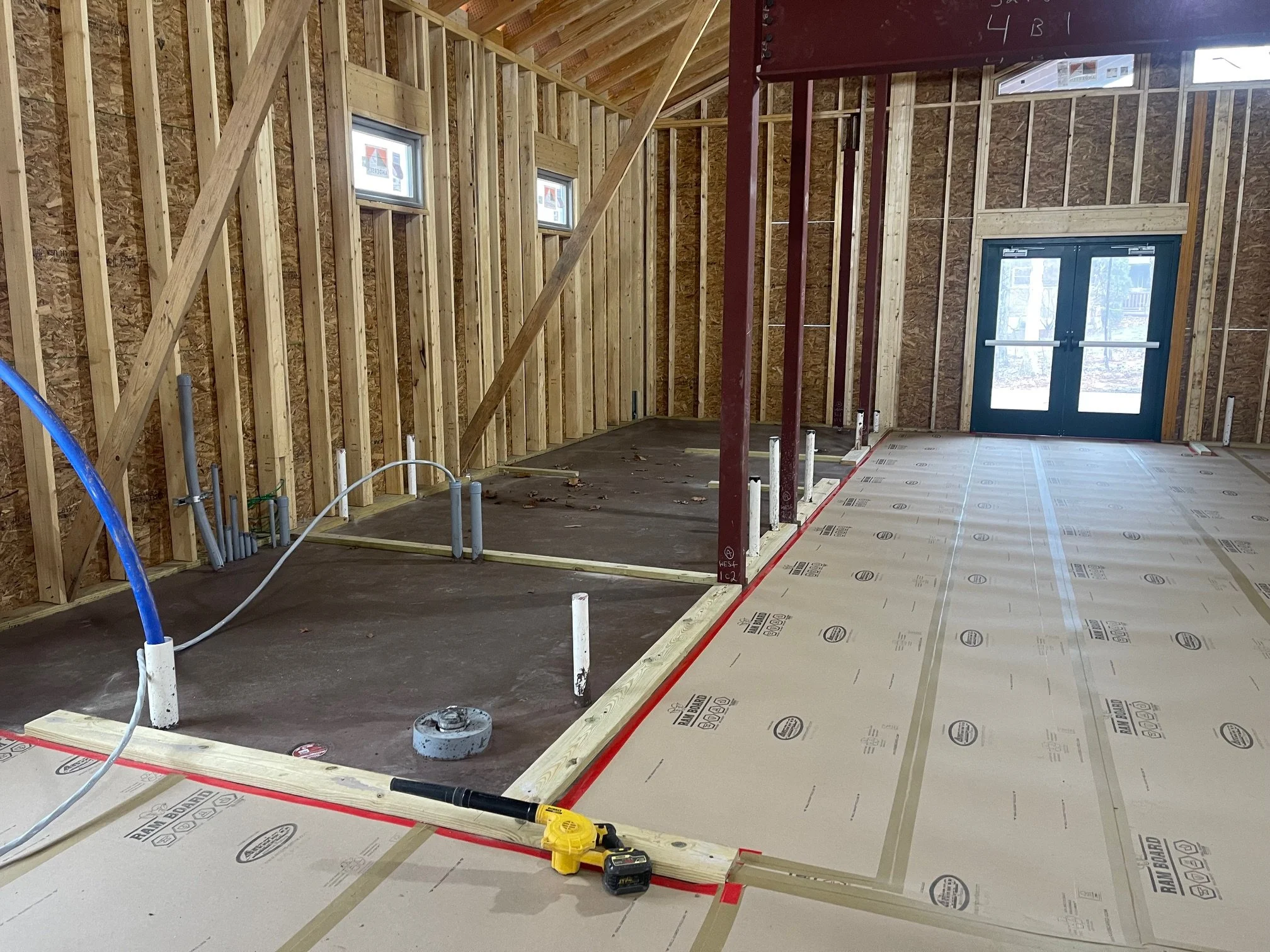

Looking from the future stage side
View fullsize

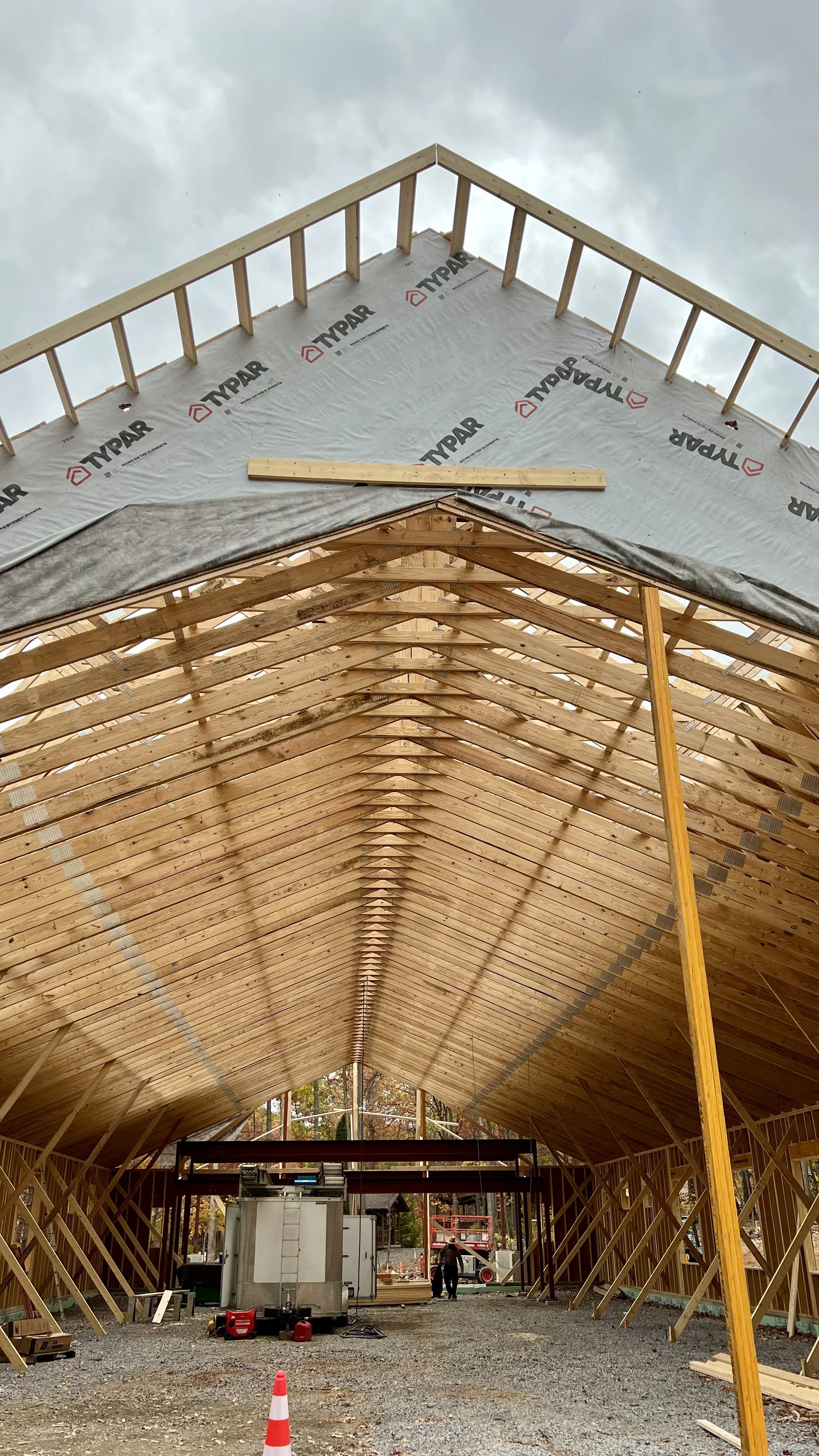

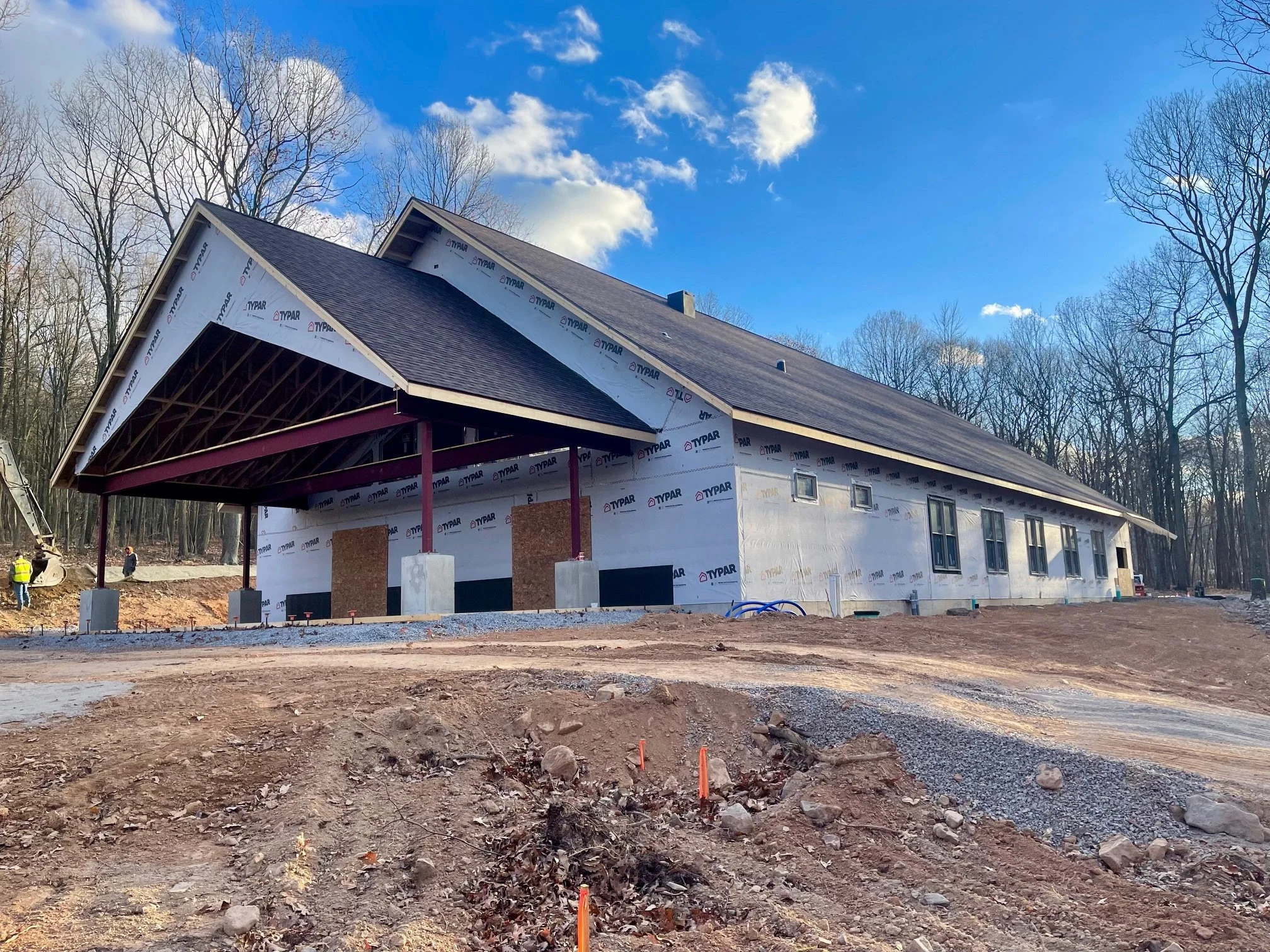

Roof is 36 ft. / Ceiling inside is 24 ft.
View fullsize

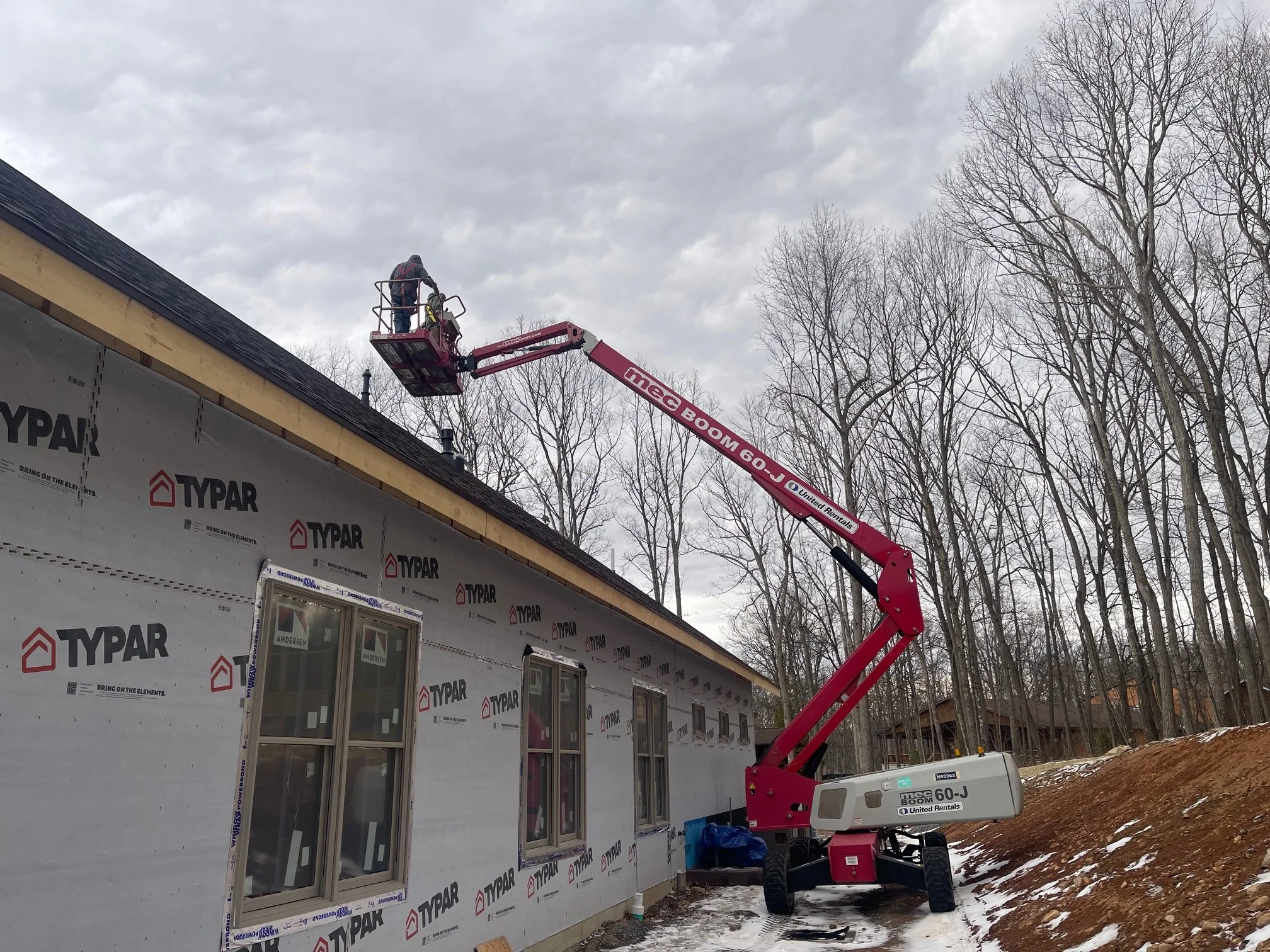

Oct. 24 - Installing shingles
View fullsize
Oct. 27 - Shingles, plumbing, conduit
View fullsize

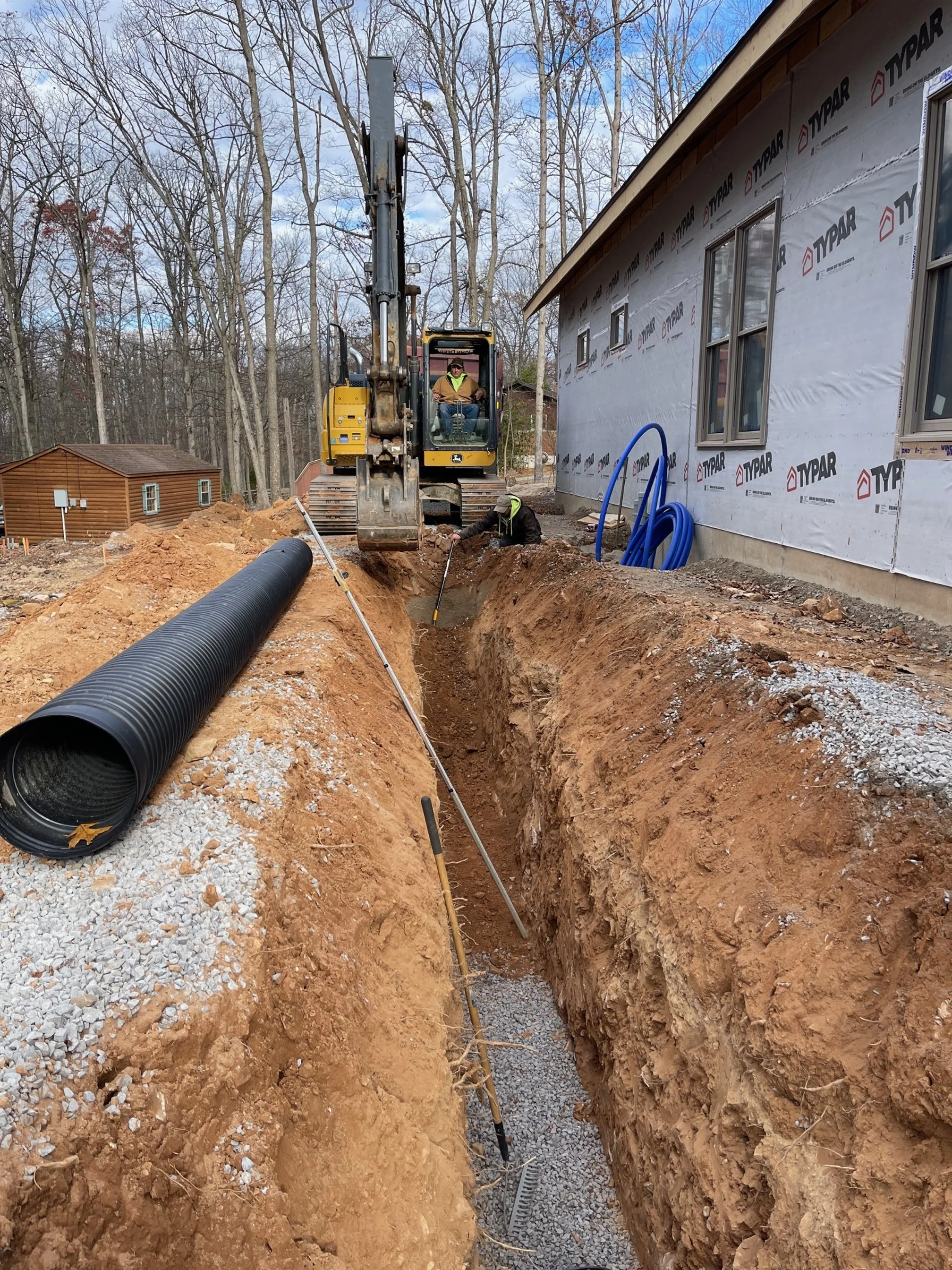

Oct. 28 - Conduit, plumbing, stormwater
View fullsize

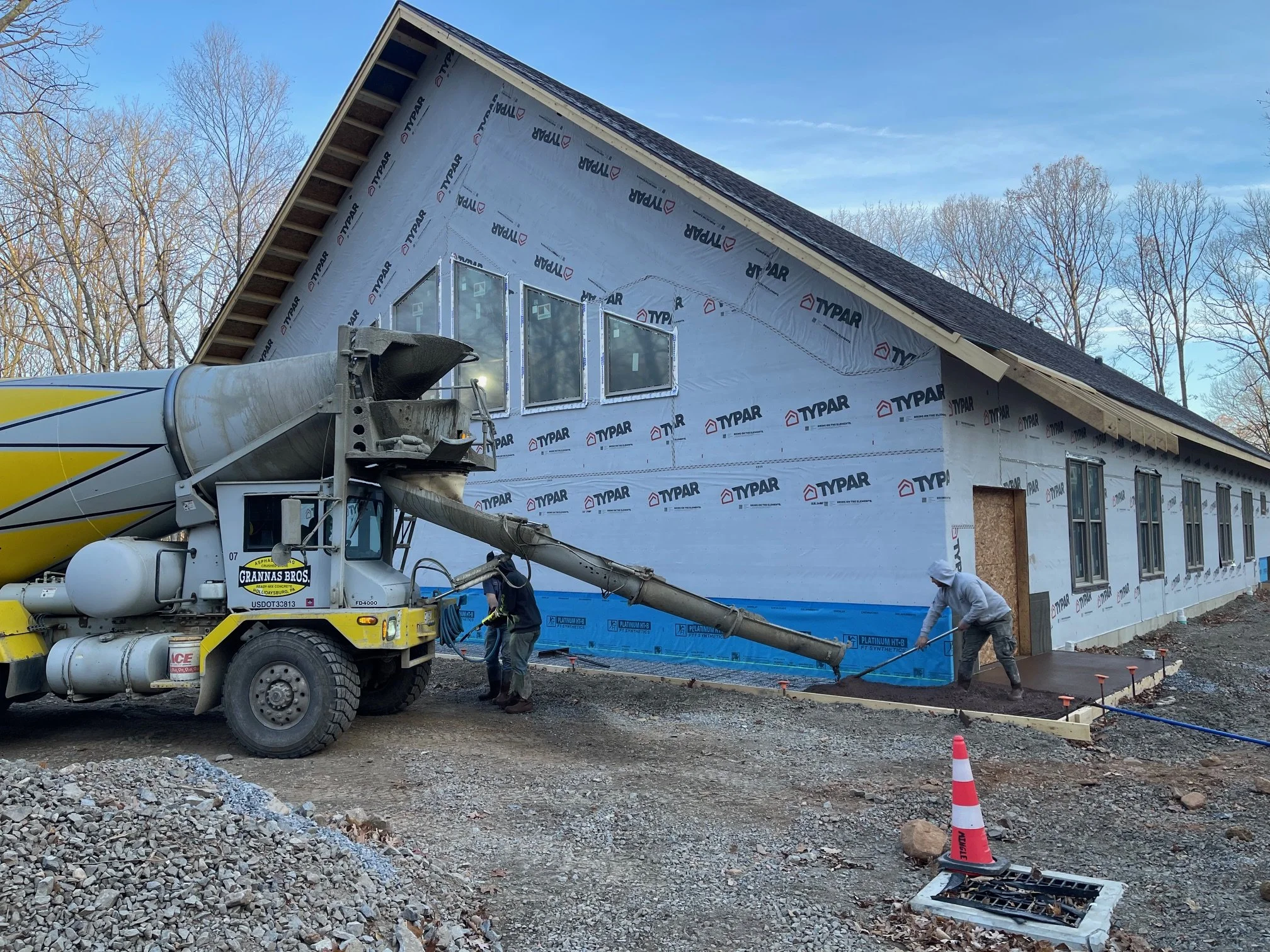

Oct. 30 - Shale, collar ties, framing
View fullsize
Oct. 31 - Big section of roof completed
